Question: Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and complete the performance indexes table. Calculate
Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and complete the performance indexes table.
- Calculate the EACf and VACf.
- Based on your data, what is your assessment of the current status of the project?
- At completion?

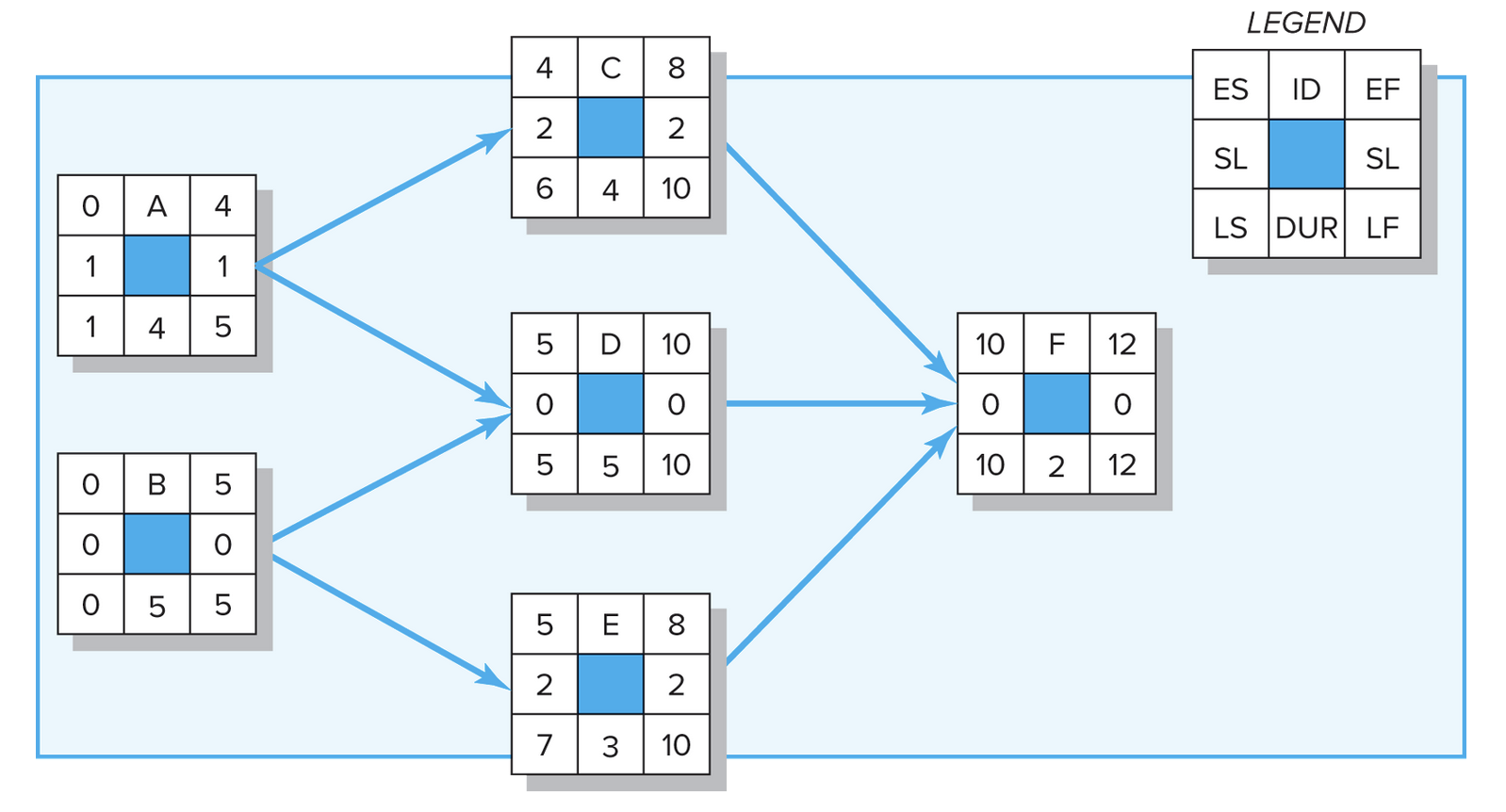

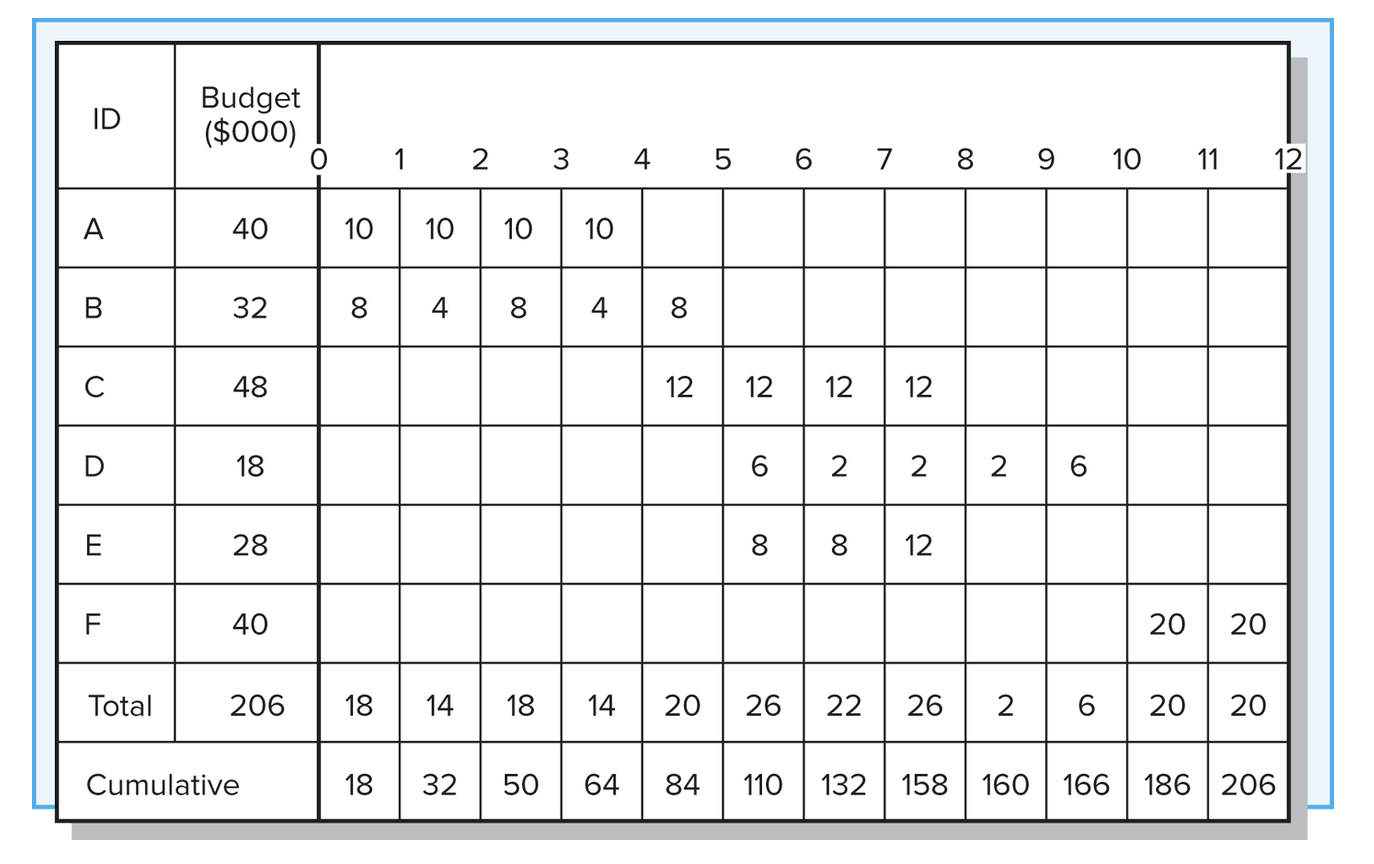

\fID Budget ($000) O 1 2 3 4 5 7 8 9 10 11 12 A 40 10 10 10 10 B 32 8 4 8 4 8 C 48 12 12 12 12 D 18 6 2 2 2 6 E 28 8 8 12 F 40 20 20 Total 206 18 14 18 14 20 26 22 26 2 6 20 20 Cumulative 18 32 50 64 84 110 132 158 160 166 186 206Status Report: Ending Period 2 ($000) Task % Complete EV AC PV CV SV A 75% 25 B 50% 12 Cumulative Totals 37 Status Report: Ending Period 4 ($000) Task % Complete EV AC PV CV SV A 100% 35 B 100% 24 Cumulative Totals 59 Status Report: Ending Period 6 ($000) Task % Complete EV AC PV CV SV A 100% 35 B 100% 24 C 75% 24 D 0% 0 E 50% 10 Cumulative Totals 93Status Report: Ending Period 8 ($000) Task Complete EV AC PV CV SV A 100% 35 B 100% 24 C 100% 32 D 33% 20 E 100% 20 Cumulative Totals 131 Performance Indexes Summary Period EV AC PV SPI CPI PCI-B 2 4 6 8 EACf = VACf =
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
