Question: Given the project network and baseline information below, complete the form to develop a status report for the project at the end of period 4.
Given the project network and baseline information below, complete the form to develop a status report for the project at the end of period 4. From the data you have collected and computed for periods 4, what information are you prepared to tell the customer about the status of the project at the end of period 4?

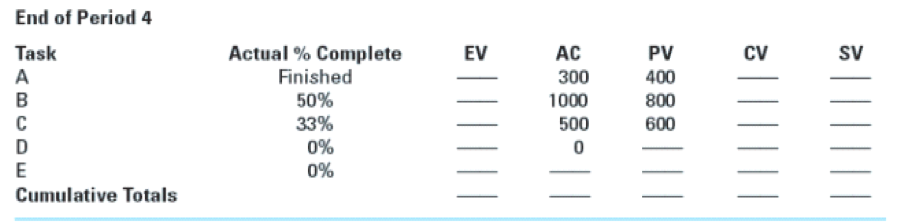

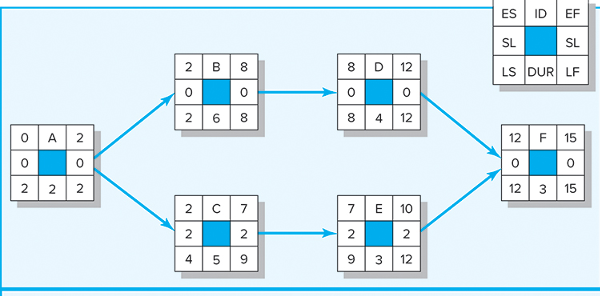

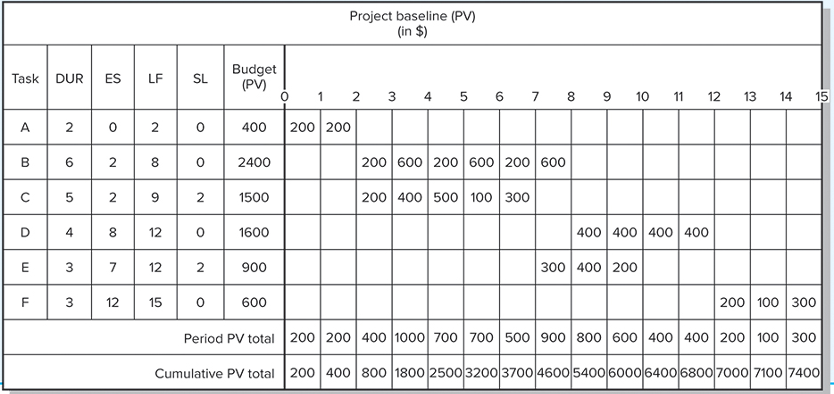

ESID EF SL SL LS DUR LF 2 B 8 0 26 8 0 o 8 D 12 0 8 4 12 O|A|2 0 2 2 2 O 12 F 15 o o 123 15 2 C7 7 E 10 2 2 2 2 4 5 9 9 12 Project baseline (PV) (in $) Task DUR ES LF SL Budget (PV) 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 A N o 2 0 400 200 200 B 6 2 8 o 2400 200 600 200 600 200 600 5 2 9 N 1500 200 400 500 100 300 D 4 8 12 0 1600 400 400 400 400 E 7 12 N 900 300 400 200 3 3 12 15 0 600 200 100 300 Period PV total 200 200 400 1000 700 700 500 900 800 600 400 400 200 100 300 Cumulative PV total 200 400 800 1800 2500 3200 3700 4600 54006000 6400 6800 7000 7100 7400 EV CV SV End of Period 4 Task B D E Cumulative Totals Actual % Complete Finished 50% 33% 0% 0% AC 300 1000 500 0 PV 400 800 600 |||||| | |
