Question: PLEASE NOTE THAT I DO NOT NEED THE MATH PART, that is just for you to be able to answer the below questions. Question #1-

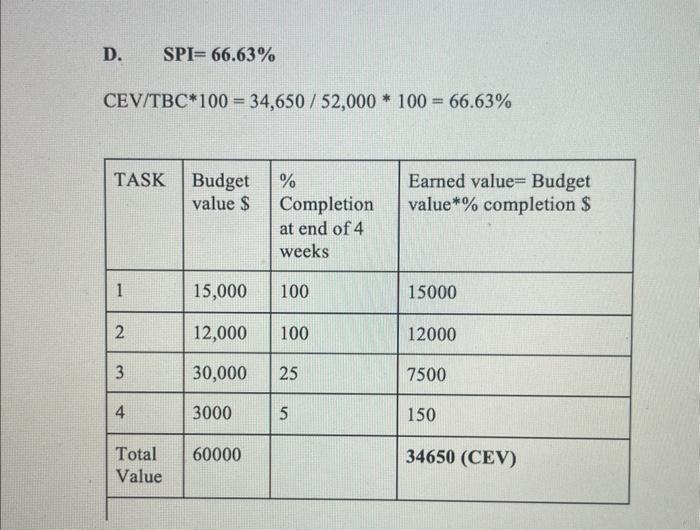

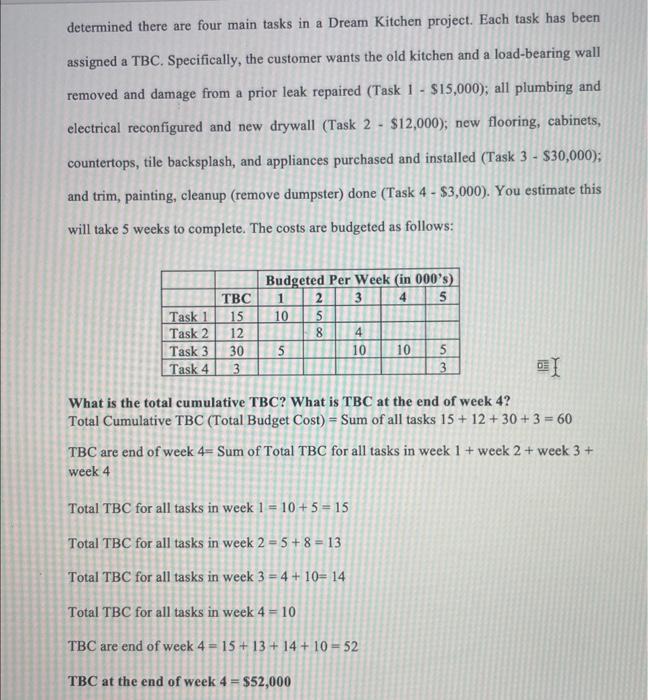

determined there are four main tasks in a Dream Kitchen project. Each task has been assigned a TBC. Specifically, the customer wants the old kitchen and a load-bearing wall removed and damage from a prior leak repaired (Task 1 - $15,000 ); all plumbing and electrical reconfigured and new drywall (Task 2 - $12,000 ); new flooring, cabinets, countertops, tile backsplash, and appliances purchased and installed (Task 3$30,000); and trim, painting, cleanup (remove dumpster) done (Task 4$3,000 ). You estimate this will take 5 weeks to complete. The costs are budgeted as follows: What is the total cumulative TBC? What is TBC at the end of week 4 ? Total Cumulative TBC (Total Budget Cost) = Sum of all tasks 15+12+30+3=60 TBC are end of week 4= Sum of Total TBC for all tasks in week 1+ week 2+ week 3+ week 4 Total TBC for all tasks in week 1=10+5=15 Total TBC for all tasks in week 2=5+8=13 Total TBC for all tasks in week 3=4+10=14 Total TBC for all tasks in week 4=10 TBC are end of week 4=15+13+14+10=52 TBC at the end of week 4=$52,000 Total cumulative TBC=$60,000 - Assume 4 weeks have passed and these are the actual costs per week: What is the CAC at the end of week 4 ? CAC= Cumulative cost up until the end of the four weeks. To calculate CAC, we need to find the sum of actual costs incurred in these 4 weeks. Week 1 actual cost + Week 2 Actual cost + Week 3 Actual cost + Week 4 Actual cost. =9,000+3,000+4,000+1,000+7,000+6,000+3,000+3,000=36,000 Therefore the CAC at the end of the four weeks is 36,000 Below is the cumulative percentage of work completed per task per week: What are the CEV, CPI, and CV at the end of week 4 ? What is the SPI? A. Cumulative Eamed value ( CEV )=$34650. B. CPI at the end of four weeks =96.25%. CVE/CAC100=34,650/36000100=96.35% C. CV at the end of four weeks =$1,350. D. SPI =66.63% CEV/TBC100=34,650/52,000100=66.63% determined there are four main tasks in a Dream Kitchen project. Each task has been assigned a TBC. Specifically, the customer wants the old kitchen and a load-bearing wall removed and damage from a prior leak repaired (Task 1 - $15,000 ); all plumbing and electrical reconfigured and new drywall (Task 2 - $12,000 ); new flooring, cabinets, countertops, tile backsplash, and appliances purchased and installed (Task 3$30,000); and trim, painting, cleanup (remove dumpster) done (Task 4$3,000 ). You estimate this will take 5 weeks to complete. The costs are budgeted as follows: What is the total cumulative TBC? What is TBC at the end of week 4 ? Total Cumulative TBC (Total Budget Cost) = Sum of all tasks 15+12+30+3=60 TBC are end of week 4= Sum of Total TBC for all tasks in week 1+ week 2+ week 3+ week 4 Total TBC for all tasks in week 1=10+5=15 Total TBC for all tasks in week 2=5+8=13 Total TBC for all tasks in week 3=4+10=14 Total TBC for all tasks in week 4=10 TBC are end of week 4=15+13+14+10=52 TBC at the end of week 4=$52,000 Total cumulative TBC=$60,000 - Assume 4 weeks have passed and these are the actual costs per week: What is the CAC at the end of week 4 ? CAC= Cumulative cost up until the end of the four weeks. To calculate CAC, we need to find the sum of actual costs incurred in these 4 weeks. Week 1 actual cost + Week 2 Actual cost + Week 3 Actual cost + Week 4 Actual cost. =9,000+3,000+4,000+1,000+7,000+6,000+3,000+3,000=36,000 Therefore the CAC at the end of the four weeks is 36,000 Below is the cumulative percentage of work completed per task per week: What are the CEV, CPI, and CV at the end of week 4 ? What is the SPI? A. Cumulative Eamed value ( CEV )=$34650. B. CPI at the end of four weeks =96.25%. CVE/CAC100=34,650/36000100=96.35% C. CV at the end of four weeks =$1,350. D. SPI =66.63% CEV/TBC100=34,650/52,000100=66.63%
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
