Question: please provide correct answer as soon as possible The AON network for the project is provided, along with information on the normal time, crash time,


please provide correct answer as soon as possible

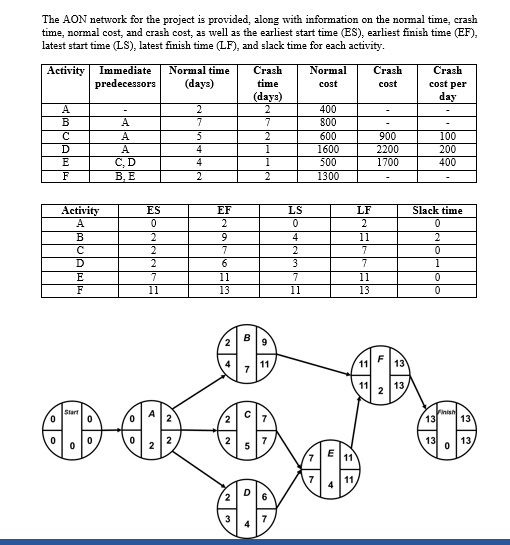

The AON network for the project is provided, along with information on the normal time, crash time, normal cost, and crash cost, as well as the earliest start time (ES), earliest finish time (EF), latest start time (LS), latest finish time (LF), and slack time for each activity. Use this information to complete this question: Crash the above project to the maximum days it can be crashed at the least cost. For each stage (day) that the project is crashed, fill out the following table. If more rows are needed, please add them manually. What happens to the slack time of activity B if the duration of activity C reduced by 2 days? Explain your
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
