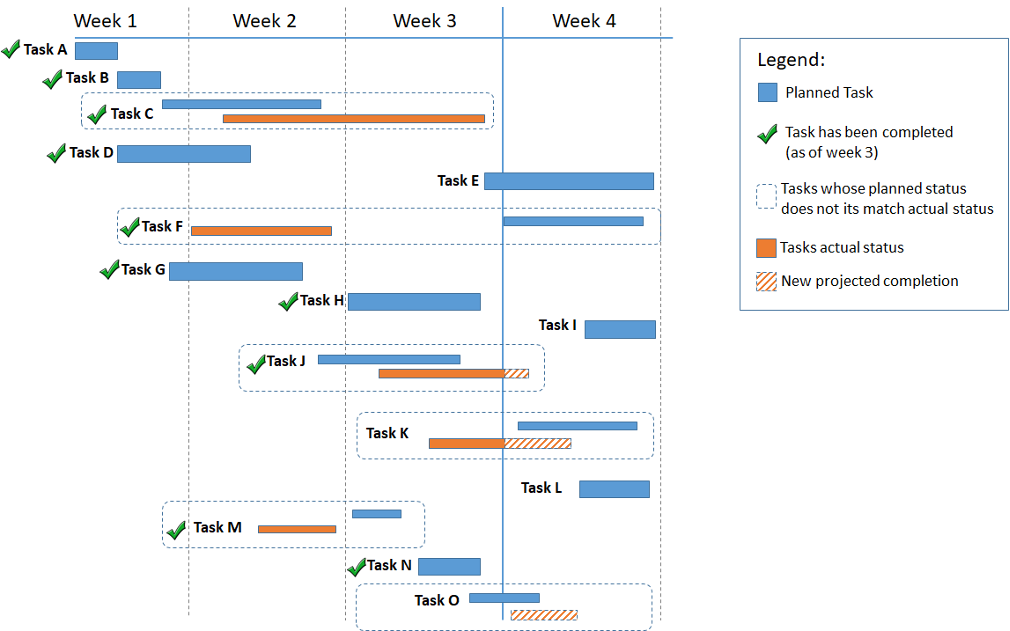

Question: Question 1: 50/50 Rule Based on the above Gantt chart, the data given below, and by using the 50/50 rule - complete the Earned Value

Question 1: 50/50 Rule
Based on the above Gantt chart, the data given below, and by using the 50/50 rule - complete the Earned Value table for tasks A, C, F, J, K M and O.
|
| Planned Value | Actual Costs | Earned Value | Notes. Use the 50/50 rule to determine how much value was earned. |
| Task A | $3,000 | $1,000 |
|
|
| Task C | $10,000 | $7,000 |
|
|
| Task F | $4,000 | $2,500 |
|
|
| Task J | $6,000 | $2,000 |
|
|
| Task K | $8,000 | $7,000 |
|
|
| Task M | $3,000 | $3,500 |
|
|
| Task O | $3,000 | $0 |
|
|
Step by Step Solution
There are 3 Steps involved in it
1 Expert Approved Answer
Step: 1 Unlock
Question Has Been Solved by an Expert!
Get step-by-step solutions from verified subject matter experts
Step: 2 Unlock
Step: 3 Unlock
