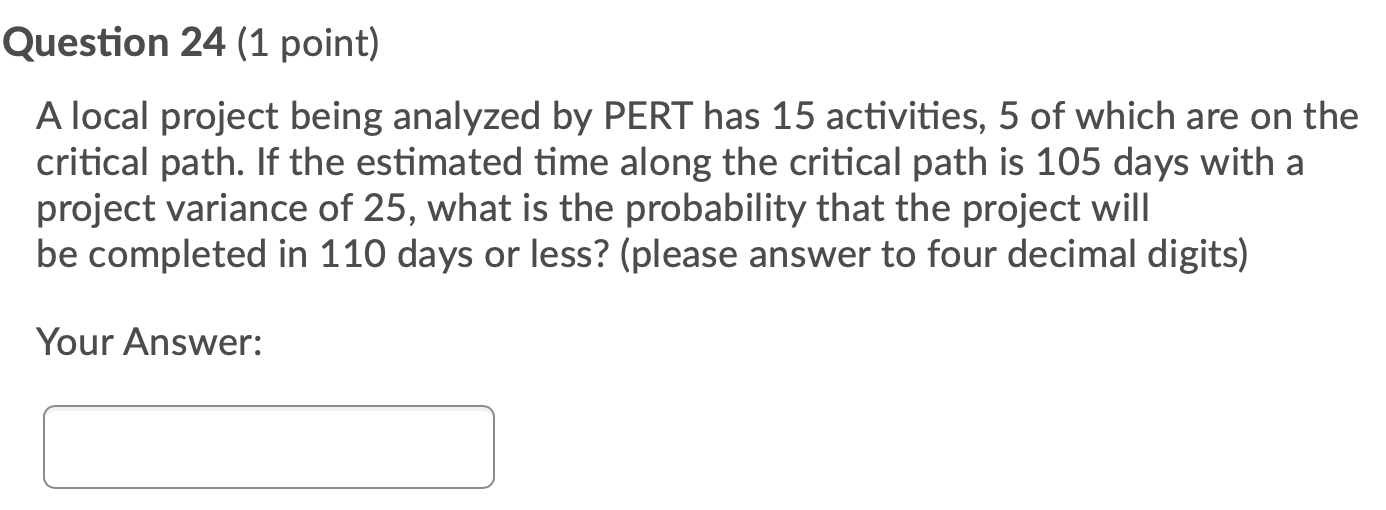

Question: Question 24 (1 point) A local project being analyzed by PERT has 15 activities, 5 of which are on the critical path. If the

Question 24 (1 point) A local project being analyzed by PERT has 15 activities, 5 of which are on the critical path. If the estimated time along the critical path is 105 days with a project variance of 25, what is the probability that the project will be completed in 110 days or less? (please answer to four decimal digits) Your Answer: Question 25 (1 point) A project whose critical path has an estimated time of 145 days with a variance of 100 has a 25% chance that the project will be completed before day (please round off to two decimal digits) Your Answer: Question 26 (1 point) If an activity whose normal duration is 70 days can be shortened to 38 days for an added cost of $3950, what is the crash cost per period? (please round off to two decimal digits) Your Answer:
