Question: Question - Please answer the below tables: Case Study #2 (Using Agile Approach - Relocation Project) Total points: 32 Project description: You are hired by

Question -

Question - Please answer the below tables: CaseQuestion - Please answer the below tables: CaseQuestion - Please answer the below tables: Case

Please answer the below tables:Question - Please answer the below tables: Case

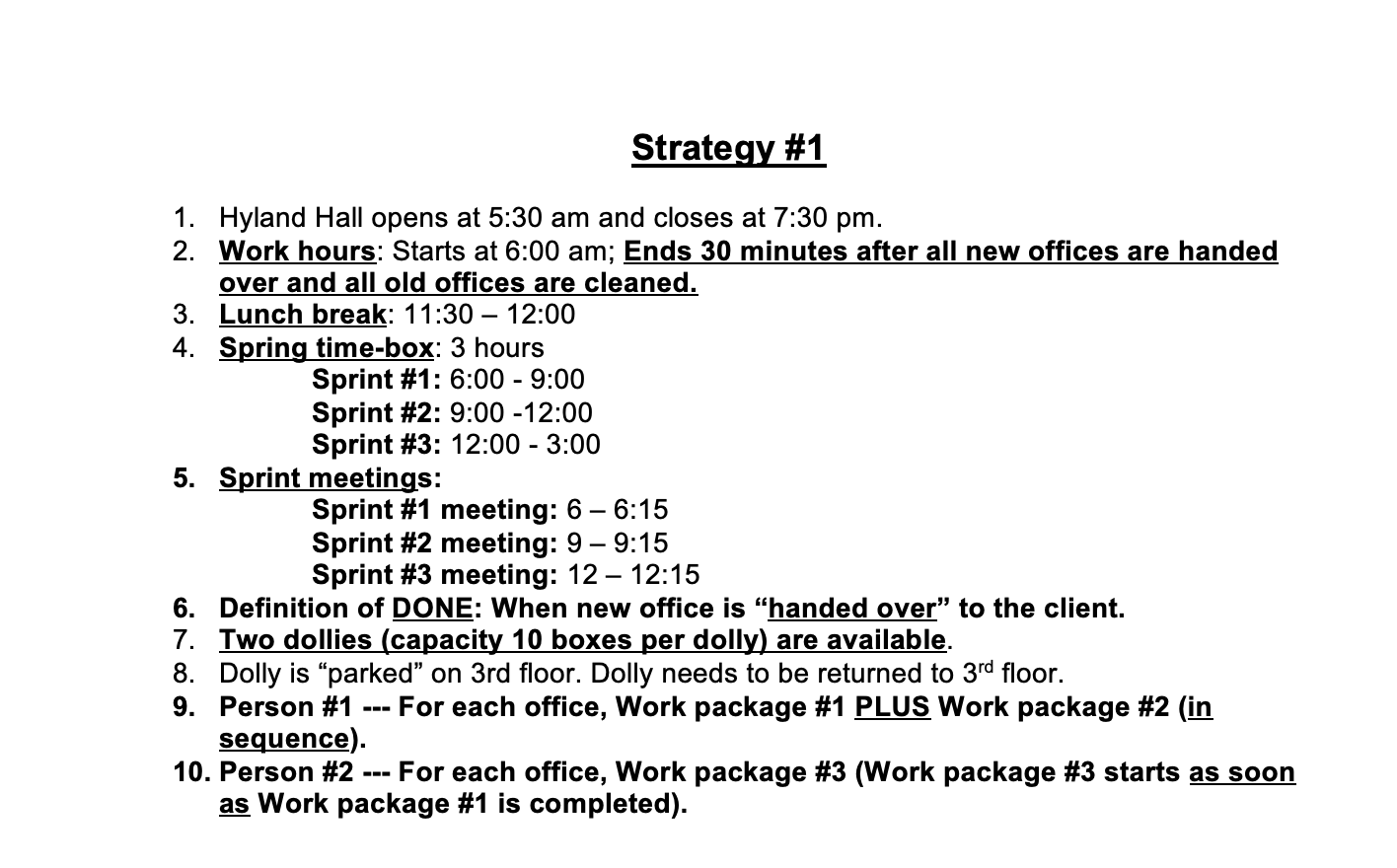

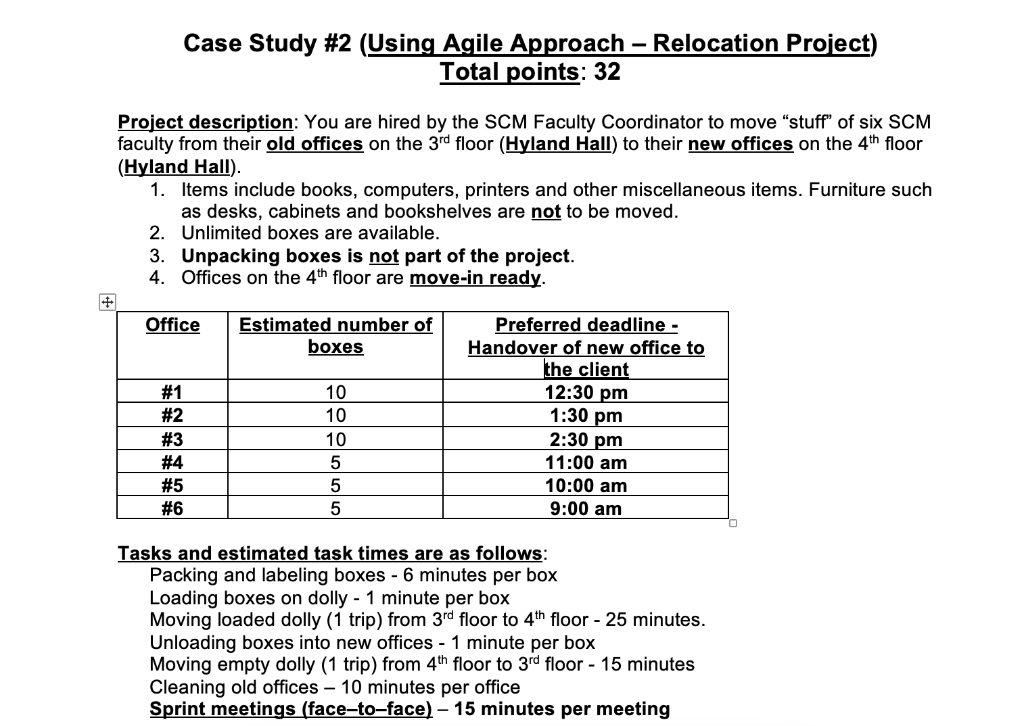

Case Study #2 (Using Agile Approach - Relocation Project) Total points: 32 Project description: You are hired by the SCM Faculty Coordinator to move "stuff" of six SCM faculty from their old offices on the 3rd floor (Hyland Hall) to their new offices on the 4th floor (Hyland Hall). 1. Items include books, computers, printers and other miscellaneous items. Furniture such as desks, cabinets and bookshelves are not to be moved. 2. Unlimited boxes are available. 3. Unpacking boxes is not part of the project. 4. Offices on the 4th floor are move-in ready. Office Estimated number of boxes #1 #2 #3 #4 #5 #6 10 10 10 5 5 5 Preferred deadline - Handover of new office to the client 12:30 pm 1:30 pm 2:30 pm 11:00 am 10:00 am 9:00 am Tasks and estimated task times are as follows: Packing and labeling boxes - 6 minutes per box Loading boxes on dolly - 1 minute per box Moving loaded dolly (1 trip) from 3rd floor to 4th floor - 25 minutes. Unloading boxes into new offices - 1 minute per box Moving empty dolly (1 trip) from 4th floor to 3rd floor - 15 minutes Cleaning old offices - 10 minutes per office Sprint meetings (face-to-face) - 15 minutes per meeting Work package #1: Pack/label boxes in old office and load boxes on dolly. Work package #2: Clean old office. Work package #3 (in sequence): Move loaded dolly to new office, unload boxes in new office and return dolly to 3rd floor). Story point for Work package #1: 3 points per box Story point for Work package #2: 5 points per clean office Story point for Work package #3: 4 points per box NOTE: The following sources can provide definition and description of concepts/terminology used in Agile Approach: i. Agile Handbook, Taxmor E. (available in Module: Agile Approach and Scrum Framework in CANVAS). ii. The Scrum Guide, Schwaber K. and Sutherland J. (available in Module: Agile Approach and Scrum Framework in CANVAS). iii. Agile Practice Guide, Published by Project Management Institute, 2017, https://www.pmi.org/pmbok-guide-standards/practice-guides/agile. Strategy #1 1. Hyland Hall opens at 5:30 am and closes at 7:30 pm. 2. Work hours: Starts at 6:00 am; Ends 30 minutes after all new offices are handed over and all old offices are cleaned. 3. Lunch break: 11:30 12:00 4. Spring time-box: 3 hours Sprint #1: 6:00 - 9:00 Sprint #2: 9:00 - 12:00 Sprint #3: 12:00 - 3:00 5. Sprint meetings: Sprint #1 meeting: 6 - 6:15 Sprint #2 meeting: 9 9:15 Sprint #3 meeting: 12 12:15 6. Definition of DONE: When new office is "handed over" to the client. 7. Two dollies (capacity 10 boxes per dolly) are available. 8. Dolly is parked" on 3rd floor. Dolly needs to be returned to 3rd floor. 9. Person #1 For each office, Work package #1 PLUS Work package #2 (in sequence). 10. Person #2 For each office, Work package #3 (Work package #3 starts as soon as Work package #1 is completed). Product Backlog (Ordered list of work at the beginning of each Sprint) Sprint # Product Backlog - Person #1? (Office #, Work package) Product Backlog - Person #2 (Office #, Work package) Sprint #1 Sprint #2 Sprint #3 Burndown Table: (Work remaining at the beginning of each Sprint) Sprint # Person #1 (Work remaining in Story points) Person #1 Time remaining (Hours, minutes) Person #2 (Work remaining Story points) Person #2 Time remaining (Hours, minutes Sprint #1 Sprint #2 Sprint #3

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
