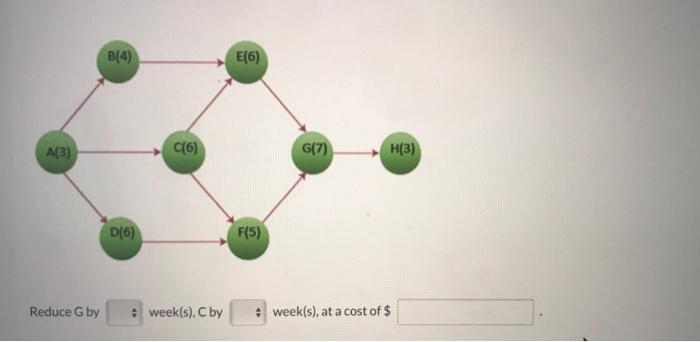

Question: show work Using the information provided in the table, the network diagram and the project completion time=25 weeks, reduce the completion time of the project
show work

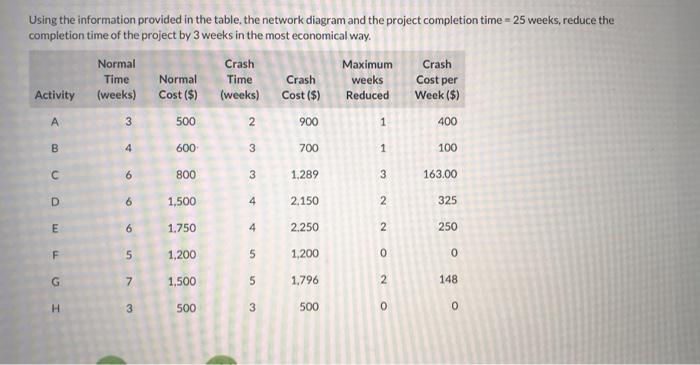

Using the information provided in the table, the network diagram and the project completion time=25 weeks, reduce the completion time of the project by 3 weeks in the most economical way. Normal Crash Time (weeks) Normal Cost ($) Time (weeks) Crash Cost (5) Maximum weeks Reduced Crash Cost per Week (5) Activity 3 500 2. 900 1 400 B 4 4 600 3 3 700 1 100 6 800 3 1.289 3 163.00 D 6 1,500 4 2.150 2 325 E 6 1.750 4 4 2.250 2 250 2 0 F 5 1,200 5 5 1,200 0 G N 1,500 5 5 1,796 2 148 H 3 500 3 500 0 0 B[4) E(6) A(3) (6) G(7) H(3) D(6) F(5) Reduce G by week(s), C by week(s), at a cost of $
