Question: The project network along with normal and crash data are provided below. Crash the project network by 4 days. What added cost is required to

The project network along with normal and crash

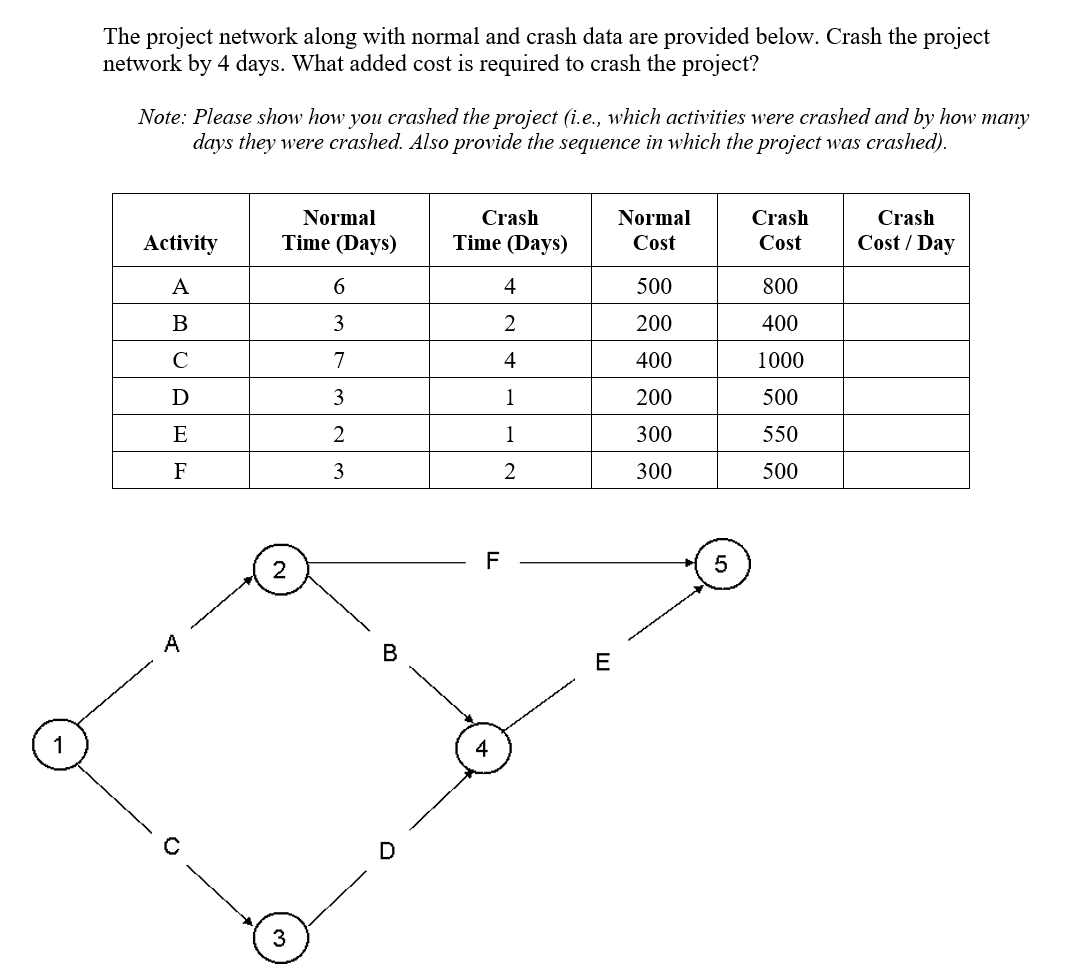

The project network along with normal and crash data are provided below. Crash the project network by 4 days. What added cost is required to crash the project? Note: Please show how you crashed the project (i.e., which activities were crashed and by how many days they were crashed. Also provide the sequence in which the project was crashed). Normal Time (Days) Crash Time (Days) Normal Cost Crash Cost Crash Cost/Day Activity A 6 4 500 800 B 3 2 200 400 7 4 400 1000 D 3 1 200 500 E 2 1 300 550 F 3 2 300 500 2 F 5 A B E 3
