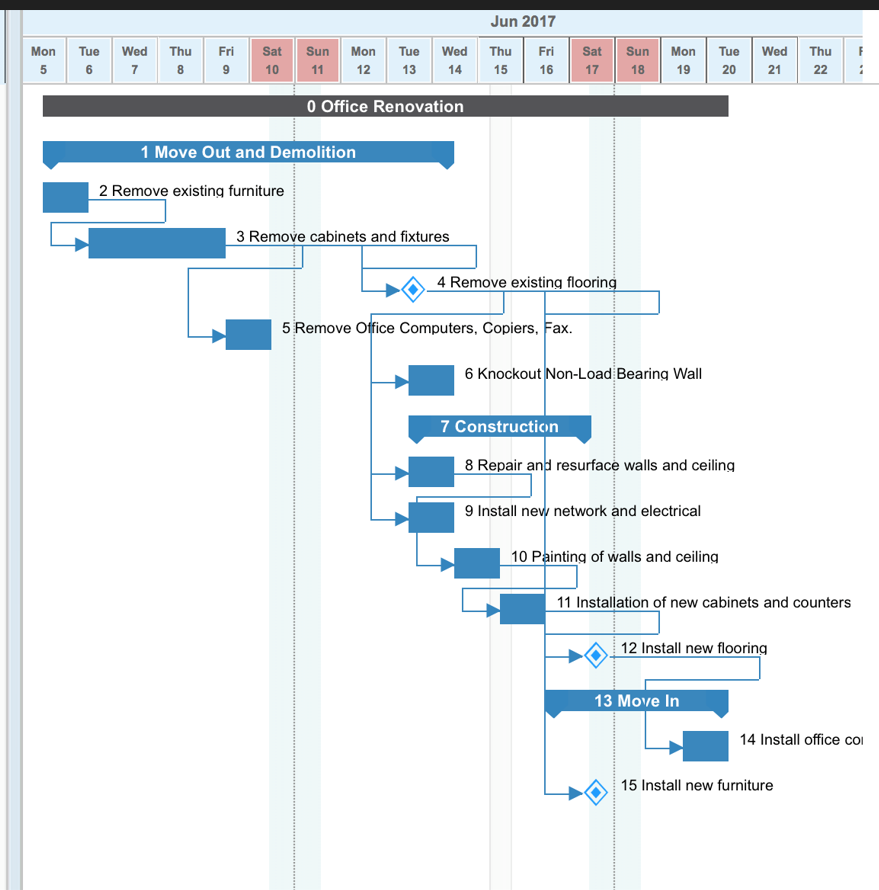

Question: The Work Breakdown Structure (WBS) and Gantt Chart below are meant to describe the process for a simple office renovation. Five outside people are involved

The Work Breakdown Structure (WBS) and Gantt Chart below are meant to describe the process for a simple office renovation. Five outside people are involved in this renovation: a furniture person, a cabinet person, a flooring person, a technology person, and a carpenter. Each worker may only work 8 hours per day and may not work on Saturday or Sundays. There are several issues with the WBS and Gantt Chart. (It is permissible to download the image to your computer so that you can zoom to better see some details.) For the items below, indicate whether they are ok as is or need to be corrected in order for the project to be successful. (Assume that 1 day = 8 hours)

The Work Breakdown Structure (WBS) and Gantt

The Work Breakdown Structure (WBS) and Gantt

Answers for each are Yes, this item is correct or No, this needs to be corrected

1.All workers are assigned to their proper skill area.

2. Line 2 "Remove existing furniture" is sequenced correctly.

3. Line 15 "Install new furniture" can for sure happen without conflict.

4. Line 10 "Painting of walls and ceiling" has a correct dependency.

5. Line 14 "Install office computers, copiers, fax and phones" has the correct dependency.

6. The furniture person is scheduled no more than 8 hours per day.

7. The carpenter is scheduled for no more than 8 hours per day.

8. The Milestone Tasks are correctly identified and sequenced.

9. Tuesday, June 13, has several tasks scheduled but since they are no conflicting tasks there is no cause for concern.

10. Line 12 "Install new flooring" can happen without conflict with other tasks.

11. There are currently days when workers are performing tasks at the job site simultaneously but they don't conflict.

12. All tasks have been placed in the correct subheading or category.

Thank you

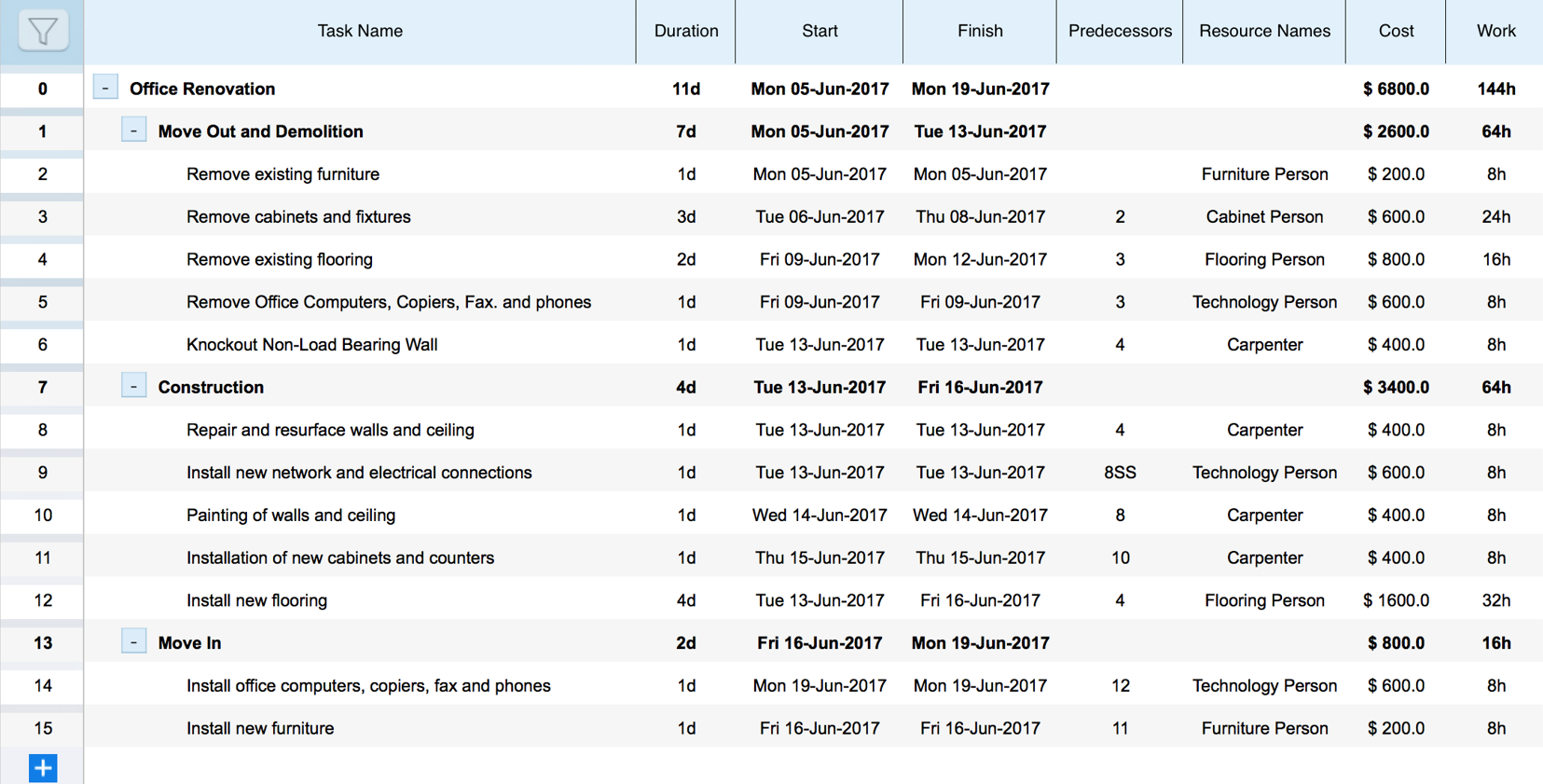

Task Name Duration Start Finish Predecessors Resource Names Cost Work 0 Office Renovation 110 Mon 05-Jun-2017 Mon 19-Jun-2017 $ 6800.0 144h 1 Move Out and Demolition 7d Mon 05-Jun-2017 Tue 13-Jun-2017 $ 2600.0 64h 2 Remove existing furniture 1d Mon 05-Jun-2017 Mon 05-Jun-2017 Furniture Person $ 200.0 8h 3 3 Remove cabinets and fixtures 3d Tue 06-Jun-2017 Thu 08-Jun-2017 2 Cabinet Person $ 600.0 24h 4 Remove existing flooring 2d Fri 09-Jun-2017 Mon 12-Jun-2017 3 Flooring Person $ 800.0 16h 5 Remove Office Computers, Copiers, Fax. and phones 1d Fri 09-Jun-2017 Fri 09-Jun-2017 3 Technology Person $ 600.0 8h 6 Knockout Non-Load Bearing Wall 1d Tue 13-Jun-2017 Tue 13-Jun-2017 4 Carpenter $ 400.0 8h 7 7 Construction 4d Tue 13-Jun-2017 Fri 16-Jun-2017 $ 3400.0 64h 00 8 Repair and resurface walls and ceiling 1d Tue 13-Jun-2017 Tue 13-Jun-2017 4 Carpenter $ 400.0 8h 9 Install new network and electrical connections 1d Tue 13-Jun-2017 Tue 13-Jun-2017 8SS Technology Person $ 600.0 8h 55 10 Painting of walls and ceiling 1d Wed 14-Jun-2017 Wed 14-Jun-2017 8 Carpenter $ 400.0 8h 11 Installation of new cabinets and counters 1d Thu 15-Jun-2017 Thu 15-Jun-2017 10 Carpenter $ 400.0 8h d 12 Install new flooring 4d Tue 13-Jun-2017 Fri 16-Jun-2017 4 Flooring Person $ 1600.0 32h 13 Move In 2d Fri 16-Jun-2017 Mon 19-Jun-2017 $ 800.0 16h 14 Install office computers, copiers, fax and phones 1d Mon 19-Jun-2017 Mon 19-Jun-2017 12 Technology Person $ 600.0 8h 15 Install new furniture 10 Fri 16-Jun-2017 Fri 16-Jun-2017 11 Furniture Person $ 200.0 8h + Jun 2017 Sun F Mon 5 Tue 6 Wed 7 Thu 8 Fri 9 Sat 10 Sun 11 Mon 12 Tue 13 Wed 14 Thu 15 Fri 16 Sat 17 Mon 19 Tue 20 Wed 21 Thu 22 5 18 0 Office Renovation 1 Move Out and Demolition 2 Remove existing furniture 3 Remove cabinets and fixtures 4 Remove existing flooring 5 Remove Office Computers, Copiers, Fax. 6 Knockout Non-Load Bearing Wall 7 Construction 8 Repair and resurface walls and ceiling 9 Install new network and electrical 10 Painting of walls and ceiling 11 Installation of new cabinets and counters 12 Install new flooring 13 Move In 14 Install office coi 15 Install new furniture Task Name Duration Start Finish Predecessors Resource Names Cost Work 0 Office Renovation 110 Mon 05-Jun-2017 Mon 19-Jun-2017 $ 6800.0 144h 1 Move Out and Demolition 7d Mon 05-Jun-2017 Tue 13-Jun-2017 $ 2600.0 64h 2 Remove existing furniture 1d Mon 05-Jun-2017 Mon 05-Jun-2017 Furniture Person $ 200.0 8h 3 3 Remove cabinets and fixtures 3d Tue 06-Jun-2017 Thu 08-Jun-2017 2 Cabinet Person $ 600.0 24h 4 Remove existing flooring 2d Fri 09-Jun-2017 Mon 12-Jun-2017 3 Flooring Person $ 800.0 16h 5 Remove Office Computers, Copiers, Fax. and phones 1d Fri 09-Jun-2017 Fri 09-Jun-2017 3 Technology Person $ 600.0 8h 6 Knockout Non-Load Bearing Wall 1d Tue 13-Jun-2017 Tue 13-Jun-2017 4 Carpenter $ 400.0 8h 7 7 Construction 4d Tue 13-Jun-2017 Fri 16-Jun-2017 $ 3400.0 64h 00 8 Repair and resurface walls and ceiling 1d Tue 13-Jun-2017 Tue 13-Jun-2017 4 Carpenter $ 400.0 8h 9 Install new network and electrical connections 1d Tue 13-Jun-2017 Tue 13-Jun-2017 8SS Technology Person $ 600.0 8h 55 10 Painting of walls and ceiling 1d Wed 14-Jun-2017 Wed 14-Jun-2017 8 Carpenter $ 400.0 8h 11 Installation of new cabinets and counters 1d Thu 15-Jun-2017 Thu 15-Jun-2017 10 Carpenter $ 400.0 8h d 12 Install new flooring 4d Tue 13-Jun-2017 Fri 16-Jun-2017 4 Flooring Person $ 1600.0 32h 13 Move In 2d Fri 16-Jun-2017 Mon 19-Jun-2017 $ 800.0 16h 14 Install office computers, copiers, fax and phones 1d Mon 19-Jun-2017 Mon 19-Jun-2017 12 Technology Person $ 600.0 8h 15 Install new furniture 10 Fri 16-Jun-2017 Fri 16-Jun-2017 11 Furniture Person $ 200.0 8h + Jun 2017 Sun F Mon 5 Tue 6 Wed 7 Thu 8 Fri 9 Sat 10 Sun 11 Mon 12 Tue 13 Wed 14 Thu 15 Fri 16 Sat 17 Mon 19 Tue 20 Wed 21 Thu 22 5 18 0 Office Renovation 1 Move Out and Demolition 2 Remove existing furniture 3 Remove cabinets and fixtures 4 Remove existing flooring 5 Remove Office Computers, Copiers, Fax. 6 Knockout Non-Load Bearing Wall 7 Construction 8 Repair and resurface walls and ceiling 9 Install new network and electrical 10 Painting of walls and ceiling 11 Installation of new cabinets and counters 12 Install new flooring 13 Move In 14 Install office coi 15 Install new furniture

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
