Question: You have just received your progress update for your 13 week project (it is now the end of week 9). Based on the plan, shown

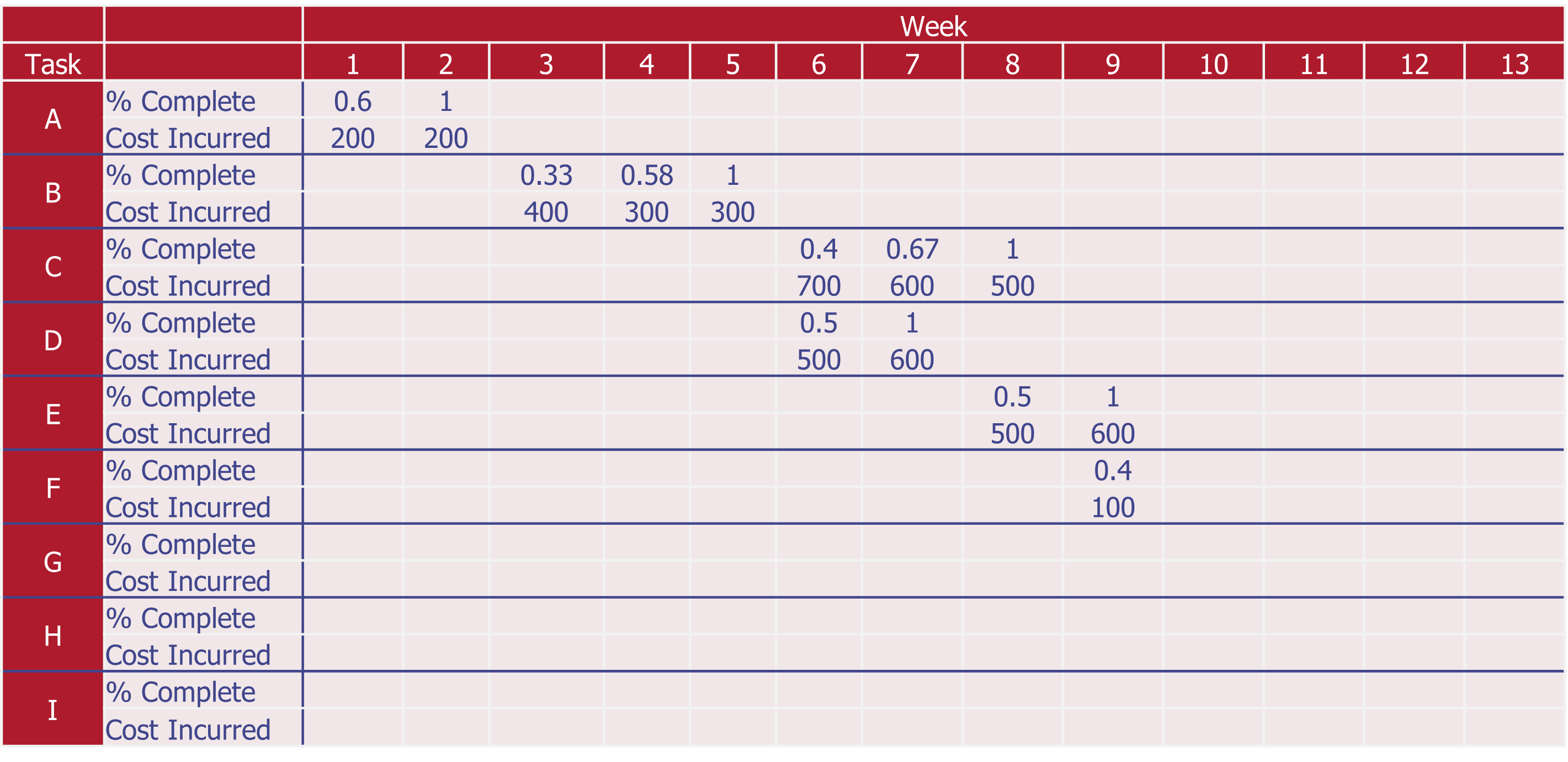

You have just received your progress update for your 13 week project (it is now the end of week 9). Based on the plan, shown in the attached Gantt Chart complete with planned costs,
- Make a short comment on the performance of your project.

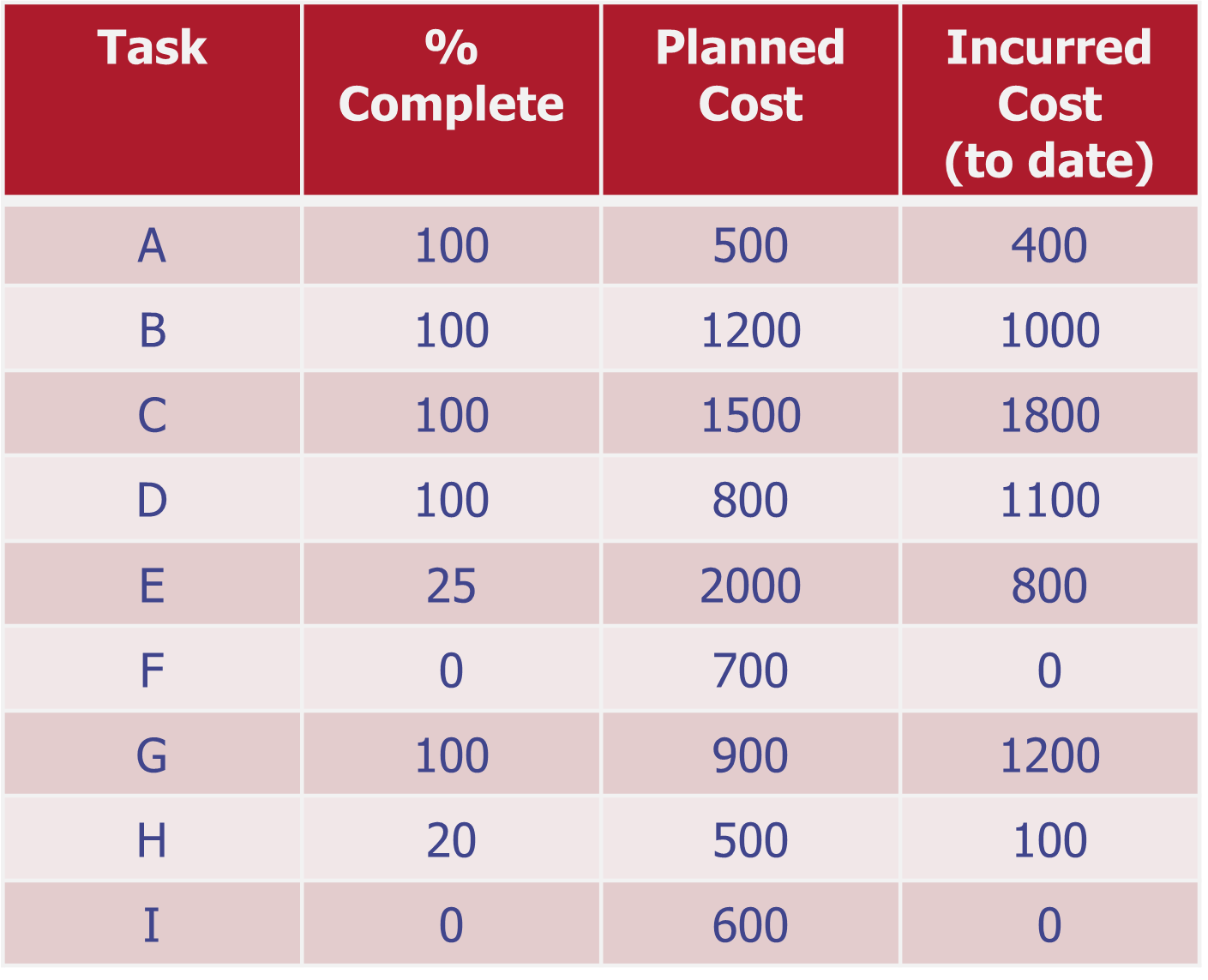

\begin{tabular}{|c|c|c|c|} \hline Task & %Complete & PlannedCost & IncurredCost(todate) \\ \hline A & 100 & 500 & 400 \\ \hline B & 100 & 1200 & 1000 \\ \hline C & 100 & 1500 & 1800 \\ \hline D & 100 & 800 & 1100 \\ \hline E & 25 & 2000 & 800 \\ \hline F & 0 & 700 & 0 \\ \hline G & 100 & 900 & 1200 \\ \hline H & 20 & 500 & 100 \\ \hline I & 0 & 600 & 0 \\ \hline \end{tabular}
