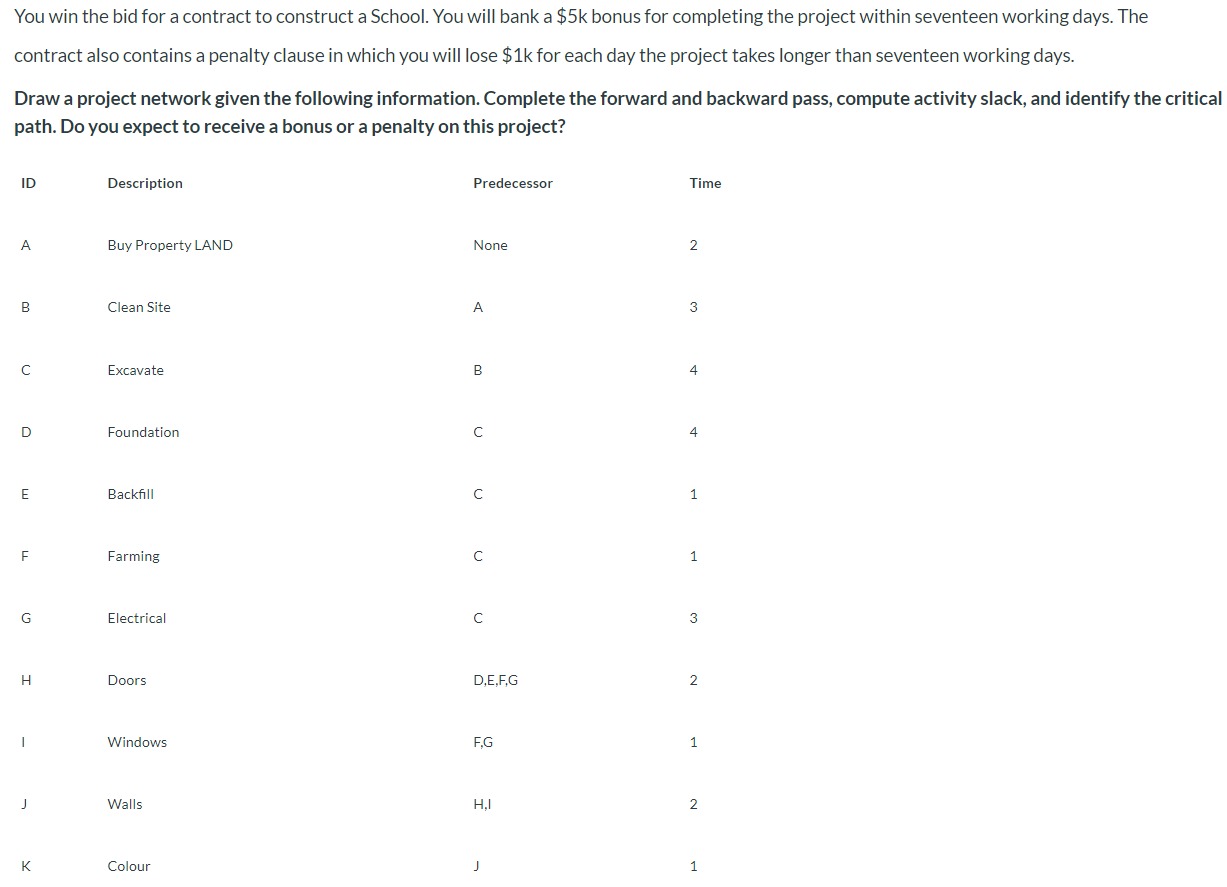

Question: You win the bid fora contract to construct a School. You will bank a $5k bonus for completing the project within seventeen working days. The


You win the bid fora contract to construct a School. You will bank a $5k bonus for completing the project within seventeen working days. The contract also contains a penalty clause in which you will lose $1k for each day the project takes longerthan seventeen working days. Draw a project network given the following information. Complete the forward and backward pass. compute activity slack, and identify the critical path. Do you expect to receive a bonus or a penalty on this project? ID Description Predecessor Time A Buyr Property LAND None 2 B Clean Site A 3 C Excavate B 4 D Foundation C 4 E Backll C 1 F Farming C 1 (3 Electrical C 3 H Doors D.E_.F.G 2 Windows F_.G 1 J Walls H_.| 2 K Colour J 1
Step by Step Solution
There are 3 Steps involved in it
Get step-by-step solutions from verified subject matter experts
