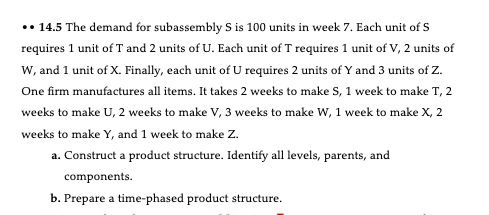

Question: * 1 4 . 5 The demand for subassembly S is 1 0 0 units in week 7 . Each unit of S requires 1

*14.5 The demand for subassembly S is 100 units in week 7. Each unit of S
requires 1 unit of T and 2 units of U. Each unit of T requires 1 unit of V,2 units of
W, and 1 unit of x. Finally, each unit of U requires 2 units of Y and 3 units of Z.
One firm manufactures all items. It takes 2 weeks to make S,1 week to make T,2
weeks to make U,2 weeks to make V,3 weeks to make W,1 week to make x,2
weeks to make Y, and 1 week to make Z.
a. Construct a product structure. Identify all levels, parents, and
components.
b. Prepare a time-phased product structure.
 *14.5 The demand for subassembly S is 100 units in week

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
