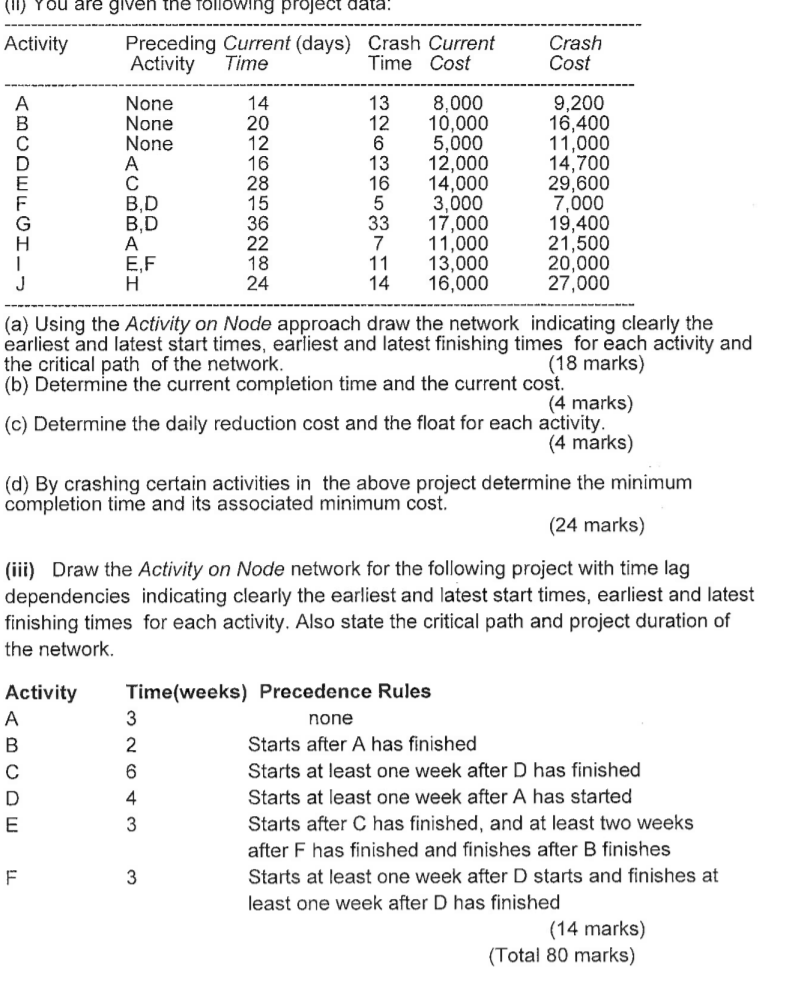

Question: (1) You are given the following project data: Activity Crash Preceding Current (days) Crash Current Activity Time Time Cost Cost 13 12 14 20 12
