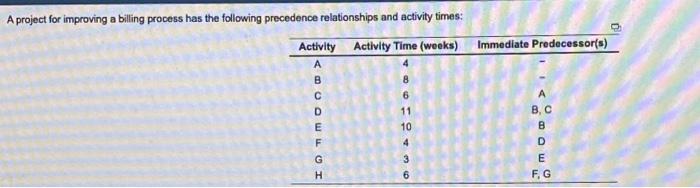

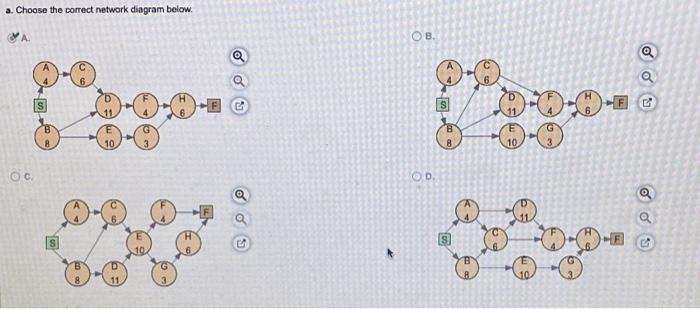

Question: A project for improving a billing process has the following precedence relationships and activity times: a. Choose the correct network diagram below. A. C. b.

A project for improving a billing process has the
A project for improving a billing process has the
A project for improving a billing process has the

A project for improving a billing process has the following precedence relationships and activity times: a. Choose the correct network diagram below. A. C. b. Calculate the slack for each activily. Which activities are on the critical path
