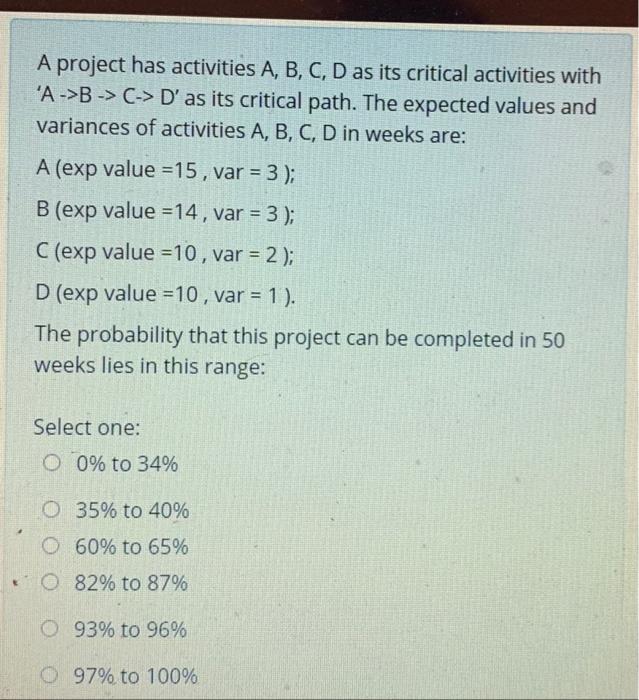

Question: A project has activities A, B, C, D as its critical activities with 'A -> -> C-> D' as its critical path. The expected values

A project has activities A, B, C, D as its
A project has activities A, B, C, D as its critical activities with 'A -> -> C-> D' as its critical path. The expected values and variances of activities A, B, C, D in weeks are: A (exp value =15, var = 3); B (exp value =14, var = 3 ); C (exp value =10, var = 2); D (exp value =10, var = 1). The probability that this project can be completed in 50 weeks lies in this range: Select one: O 0% to 34% O 35% to 40% O 60% to 65% O 82% to 87% O 93% to 96% 97% to 100%
