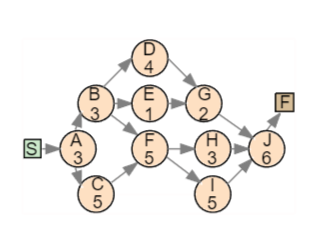

Question: Activity Activity Time (days) Immediate Predecessor(s) A 3 B 3 A C 5 A D 4 B E 1 B F 5 B, C G

Activity

Activity Time (days)

Immediate Predecessor(s)

A

3

B

3

A

C

5

A

D

4

B

E

1

B

F

5

B, C

G

2

D, E

H

3

F

I

5

F

J

6

G, H, I

Activity Activity Time (days) Immediate

The critical path is A-C-F-I-J and the project duration is 24 days.

How much slack is in each of the activities G, H, and I?

Activity

Activity

Time (days)

On critical path?

Slack

(days)

G

2

No

Yes

enter your response here

H

3

Yes

No

enter your response here

I

5

Yes

No

enter your response here

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
