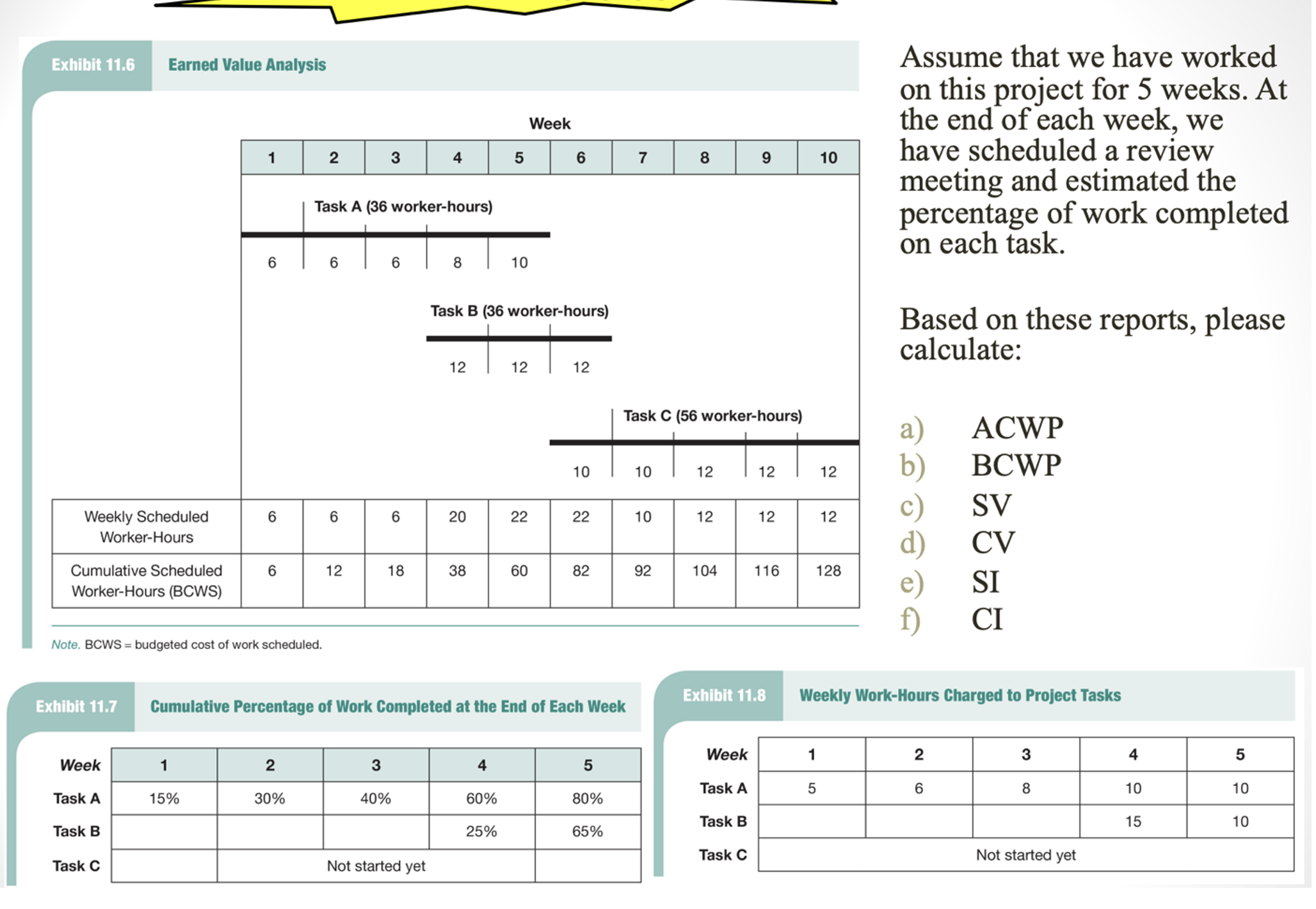

Question: Assume that we have worked on this project for 5 weeks. At the end of each week, we have scheduled a review meeting and estimated
Assume that we have worked
on this project for weeks. At
the end of each week, we
have scheduled a review
meeting and estimated the
percentage of work completed
on each task.
Based on these reports, please
calculate:
Note. BCWS budgeted cost of work scheduled.
