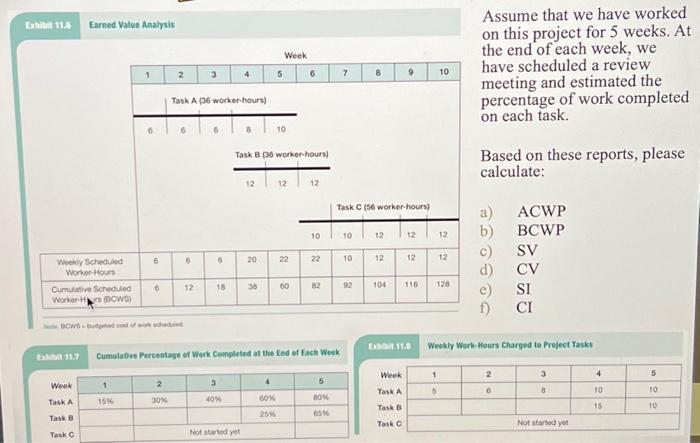

Question: Earned Value Analysis Week Assume that we have worked on this project for 5 weeks. At the end of each week, we have scheduled a
Earned Value Analysis Week Assume that we have worked on this project for 5 weeks. At the end of each week, we have scheduled a review meeting and estimated the percentage of work completed on each task. Based on these reports, please calculate: a) ACWP b) BCWP c) SV d) CV e) SI f) CI Exhant it.e Weekly Work-Hours Charged to Frolect Tasks Cumulaties Percentage of Work Completed at the End of Each Week
