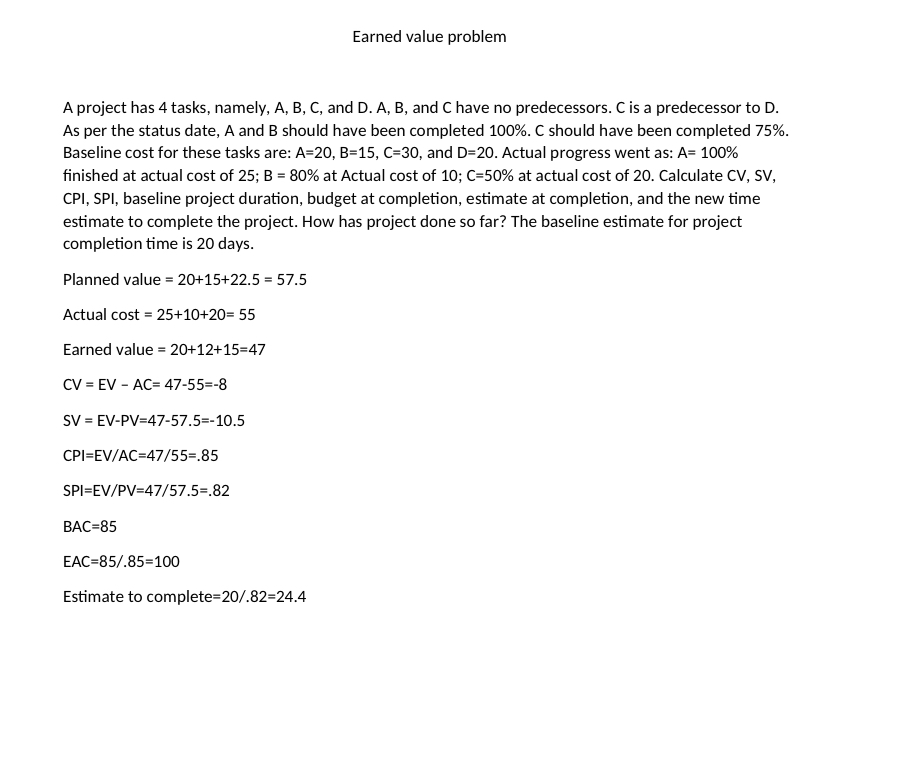

Question: Earned value problem A project has 4 tasks, namely, A , B , C , and D . A , B , and C have

Earned value problem
A project has 4 tasks, namely, A, B, C, and D. A, B, and C have no predecessors. C is a predecessor to D. As per the status date, A and B should have been completed 100%. C should have been completed 75%. Baseline cost for these task are: A=20,B=15,C=30, and D=20. Actual progress went as: A=100% finished at actual cost of 25;B=80% at Actual cost of 10;C=50% at actual cost of 20. Calculate CV, SV,CPI ,SPI , baseline project duration, budget at completion, estimate at completion, and the new time estimate to complete the project. How has project done so far? The baseline estimate for project completion time is 20 days.
Planned value =20+15+22.5=57.5
Actual cost =25+10+20=55
Earned value =20+12+15=47
CV=EV-AC=47-55=-8
SV=EV-PV=47-57.5=-10.5
CPI =EVAC=4755=.85
SPI =EVPV=4757.5=.82
BAC=85
EAC=85.85=100
Estimate to complete =20.82=24.4
 Earned value problem A project has 4 tasks, namely, A, B,

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
