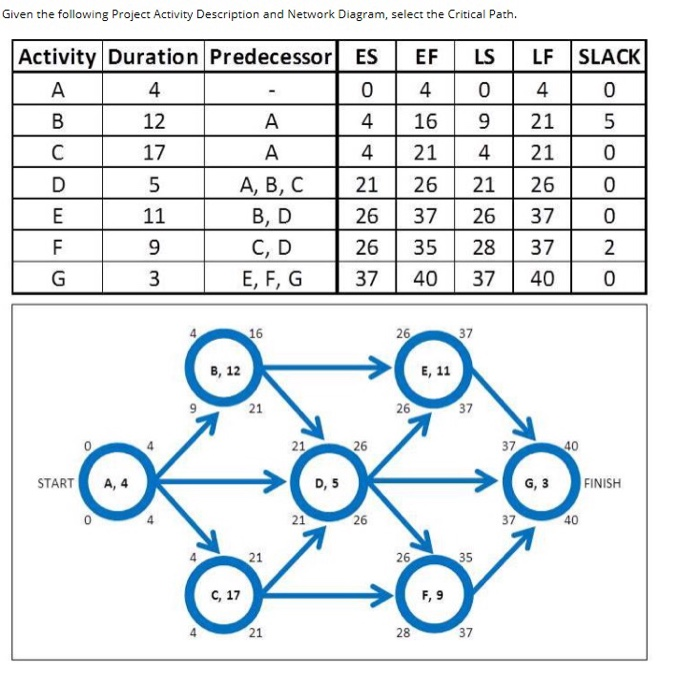

Question: Given the following Project Activity Description and Network Diagram, select the Critical Path. Activity Duration Predecessor ES EF LS LF SLACK A 4 - 0
