Question: Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8, and complete the performance indexes table. Calculate

Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8, and complete the performance indexes table. Calculate the forecasted estimate at completion (EAC) and the forecasted variance at completion (VAC). Based on your data, what is your assessment of the current status of the project? Is it at completion?

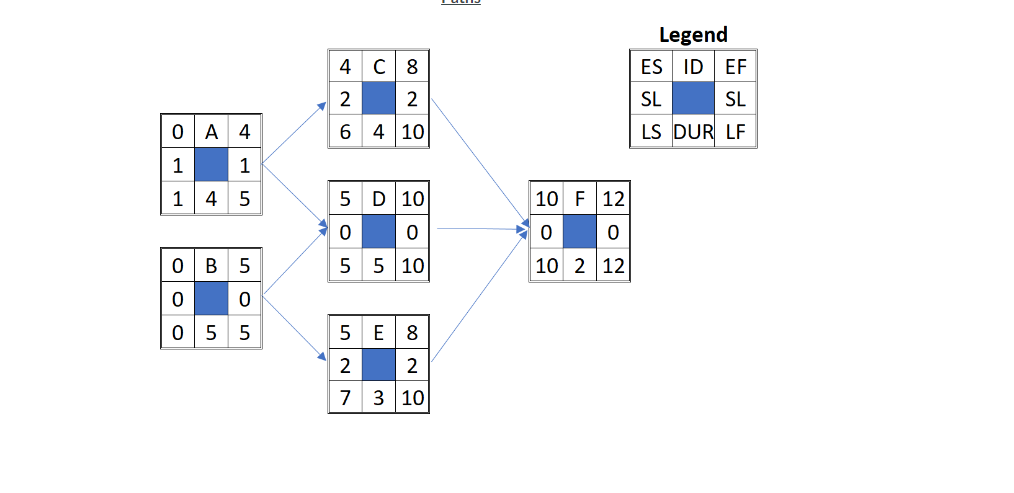

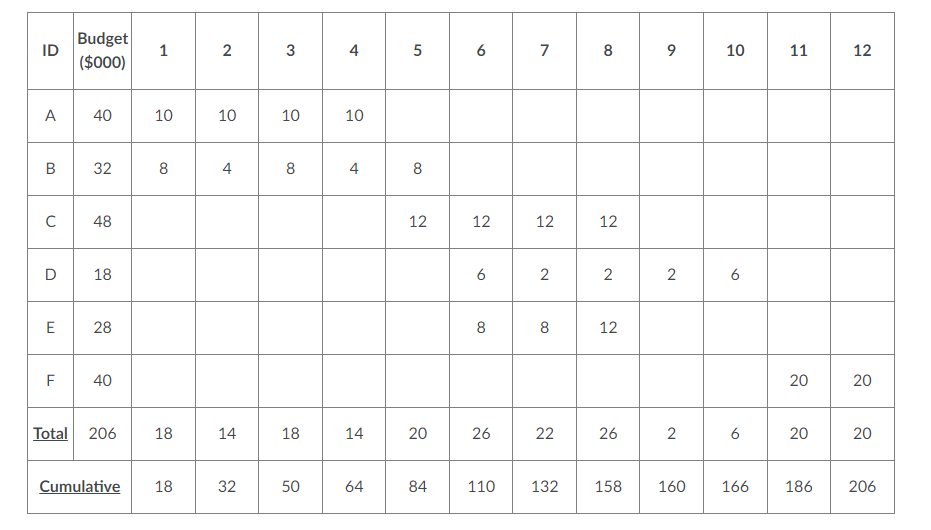

Use the project network, baseline chart, and status report table below for information
please complete the performance indexes table and explain
