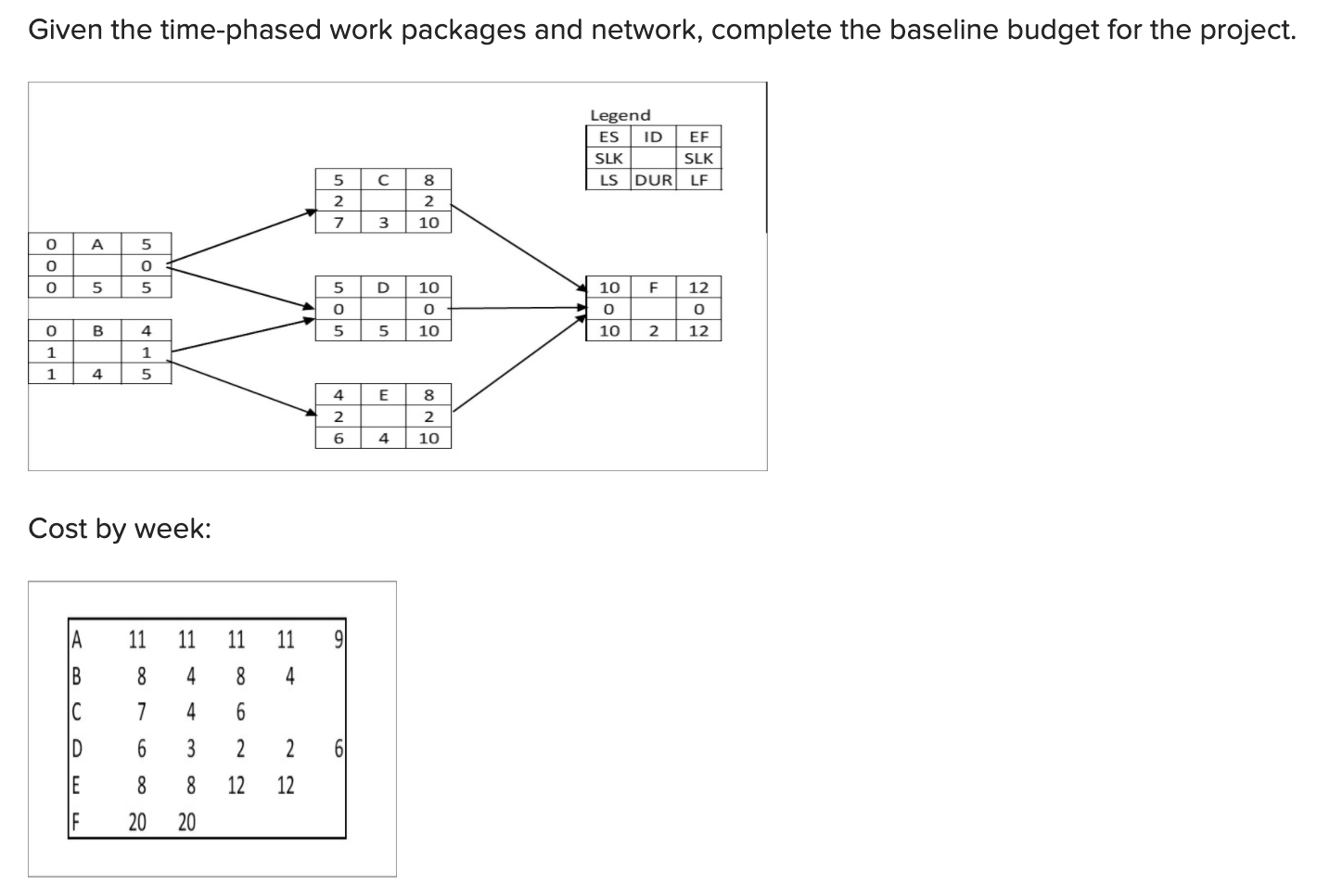

Question: Given the time-phased work packages and network, complete the baseline budget for the project. Legend ES ID EF SLK SLK LS DUR LF 5 2

Given the time-phased work packages and network,Given the time-phased work packages and network,

Given the time-phased work packages and network, complete the baseline budget for the project. Legend ES ID EF SLK SLK LS DUR LF 5 2 7 8 2 10 3 0 A 0 5 o 5 O 5 5 D 10 10 F 12 0 0 0 10 0 B 4 5 5 10 2 12 1 1 1 4 5 E 8 4 2 6 2 4 10 Cost by week: A 11 11 11 11 9 IB 8 4 8 4 IC 7 4 6 ID 6 w 2 2 61 IE 8 8 12 12 IF 20 20 Enter the appropriate values in the truncated portion of the budget form shown below. Time Periods ID Budget 2 4 5 6 7 A 53 B 24 17 D 19 E 40 F 40 Total 193 Cumulative
