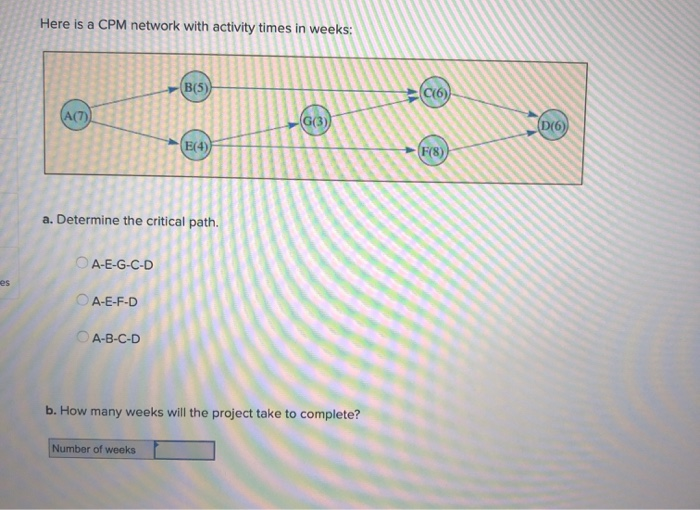

Question: Here is a CPM network with activity times in weeks: B(5) C16) A(7) G(3) D(6) E(4) F18) a. Determine the critical path. A-E-G-C-D es OA-E-F-D

Here is a CPM network with activity times in
Here is a CPM network with activity times in
Here is a CPM network with activity times in weeks: B(5) C16) A(7) G(3) D(6) E(4) F18) a. Determine the critical path. A-E-G-C-D es OA-E-F-D A-B-C-D b. How many weeks will the project take to complete? Number of weeks c. Suppose F could be shortened by two weeks and B by one week. By how many weeks would this reduce the project duration? Number of weeks reduced
