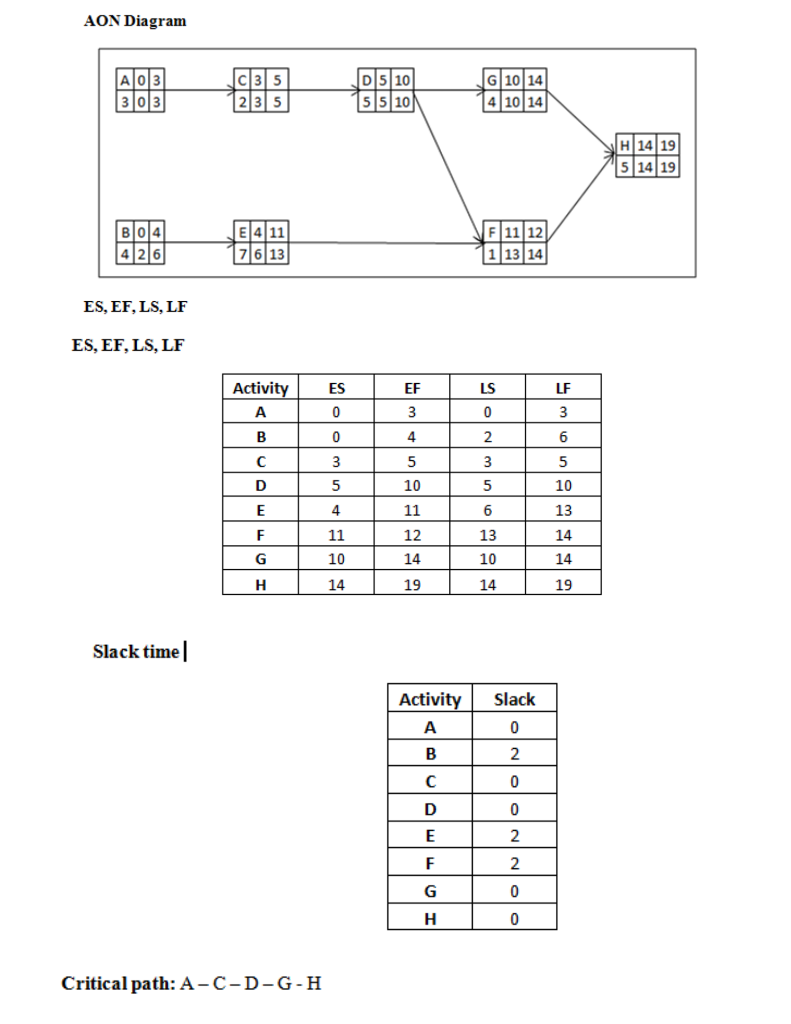

Question: How many weeks does it take to complete the project according to the critical path analysis? An activity has three estimates: Optimistic = 10 weeks,
How many weeks does it take to complete the project according to the critical path analysis?
An activity has three estimates: Optimistic = 10 weeks, Pessimistic = 25 weeks, Most-Likely = 15 weeks. What is the estimate according to the three-point estimation method for this activity? What is the standard deviation for this activity?

AON Diagram G 10 14 Alo 3 CI 3 5 D 5 10 4 10 14 3 0 3 2 3 5 515 10 Blo 4 E 4 11 F 11 12 613 1 13 14 4 216 ES, EF, LS, LF ES, EF, LS, LF Activity ES EF LS LF 10 10 11 13 14 G 10 14 10 14 H 14 19 14 19 Slack timel Activity slack Critical path: A-C-D-G-H H 14 19 5 14 19
