Question: in table 3.2 of project management example do the revised project network problem completely, show network figure, a table showing (ES, EF, LF, LS, ST),
in table 3.2 of project management example do the revised project network problem completely, show network figure, a table showing (ES, EF, LF, LS, ST), critical path, and project duration.

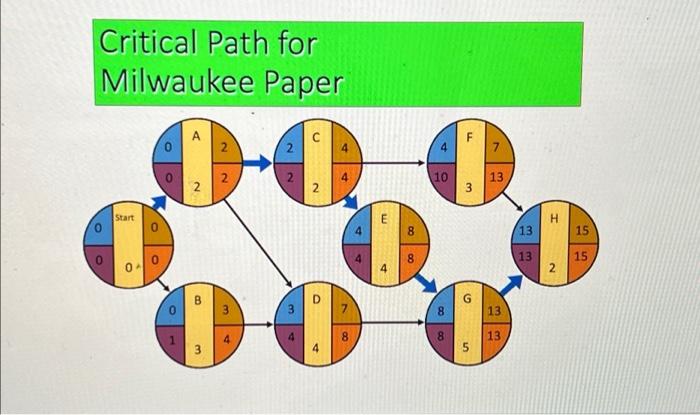

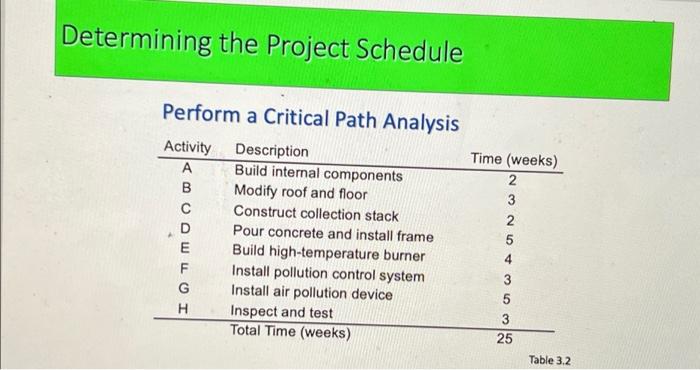

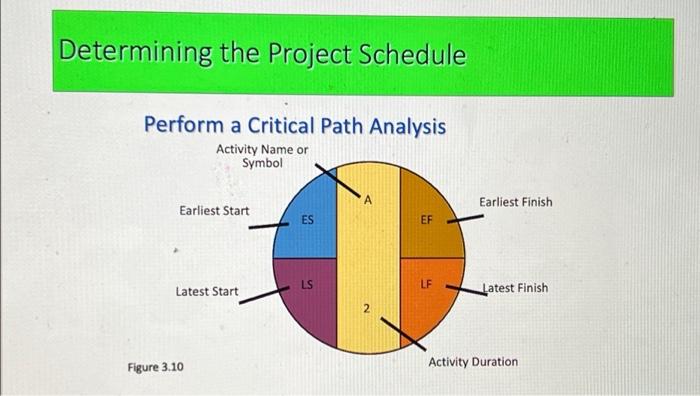

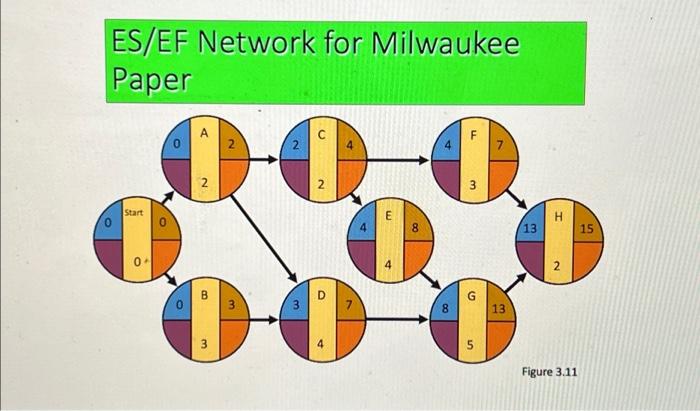

Determining the Project Schedule Perform a Critical Path Analysis Activity Description A Build internal components B Modify roof and floor C Construct collection stack D Pour concrete and install frame E Build high-temperature burner Install pollution control system Install air pollution device Inspect and test Total Time (weeks) FGH Time (weeks) 2 65E5GN WI 2 25 Table 3.2 Determining the Project Schedule Perform a Critical Path Analysis Activity Name or Symbol Earliest Start ES EF LS LF Latest Start Activity Duration Figure 3.10 N Earliest Finish Latest Finish ES/EF Network for Milwaukee Paper C 2 00 2 0 4 3 3 00 3 0 Start 0+ E 8 LL 00 3 13 O 5 13 H 2 Figure 3.11 15 LS/LF Times for Milwaukee Paper A 2 2 2 Start 0 0 1 B 3 3 4 3 4 2 0 4 4 4 7 8 A . 4 E + 00 8 4 10 8 8 F 3 G S 7 13 13 13 13 13 H 2 15 15 Critical Path for Milwaukee Paper A C 2 2 2 2 Start 0 0. 0 N B 3 3 3 4 2 O st 4 st 4 7 8 ST E 4 8 00 4 10 8 8 F 3 5 7 13 13 13 13 13 H 2 15 15 5

Step by Step Solution
There are 3 Steps involved in it
1 Expert Approved Answer
Step: 1 Unlock
Question Has Been Solved by an Expert!
Get step-by-step solutions from verified subject matter experts
Step: 2 Unlock
Step: 3 Unlock
