Question: Keep in mind that A can be crashed 2 days, from 5 down to 3 days, etc. - What is the late finish time for

Keep in mind that A can be crashed 2 days, from 5 down to 3 days, etc.
- What is the late finish time for Task E assuming no crashing?
- What is the late finish time for task B assuming no crashing?
- What is the late START time for task D assuming no crashing?
- How much total slack is associated with task B assuming no crashing?

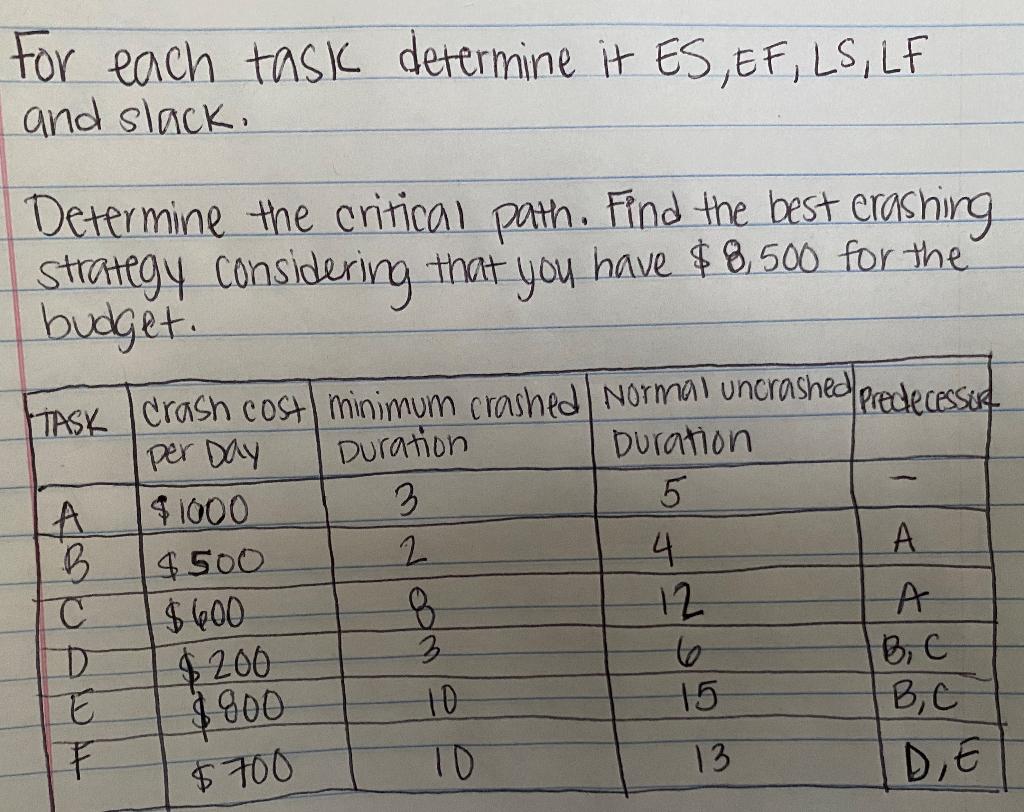

Please & thank you! I look forward to giving a positive rating.
For each task determine it ES, EF, LS, LF and slack. Determine the critical path. Find the best crashing strategy considering that you have $8.500 for the budget. FTASK crash cost minimum crashed Normal uncrashed predecessor per day Duration Duration LA $1000 3 5 B $500 2 4 $ 600 B 12 Ar A $200 6 , E $800 15 B, C DE A Hotdot 3 10 13 $700Step by Step Solution
