Question: Please help me. Thank you 3. Complete a network diagram for the Rockworkz project. Refer to the task list below. It is the same task

Please help me. Thank you

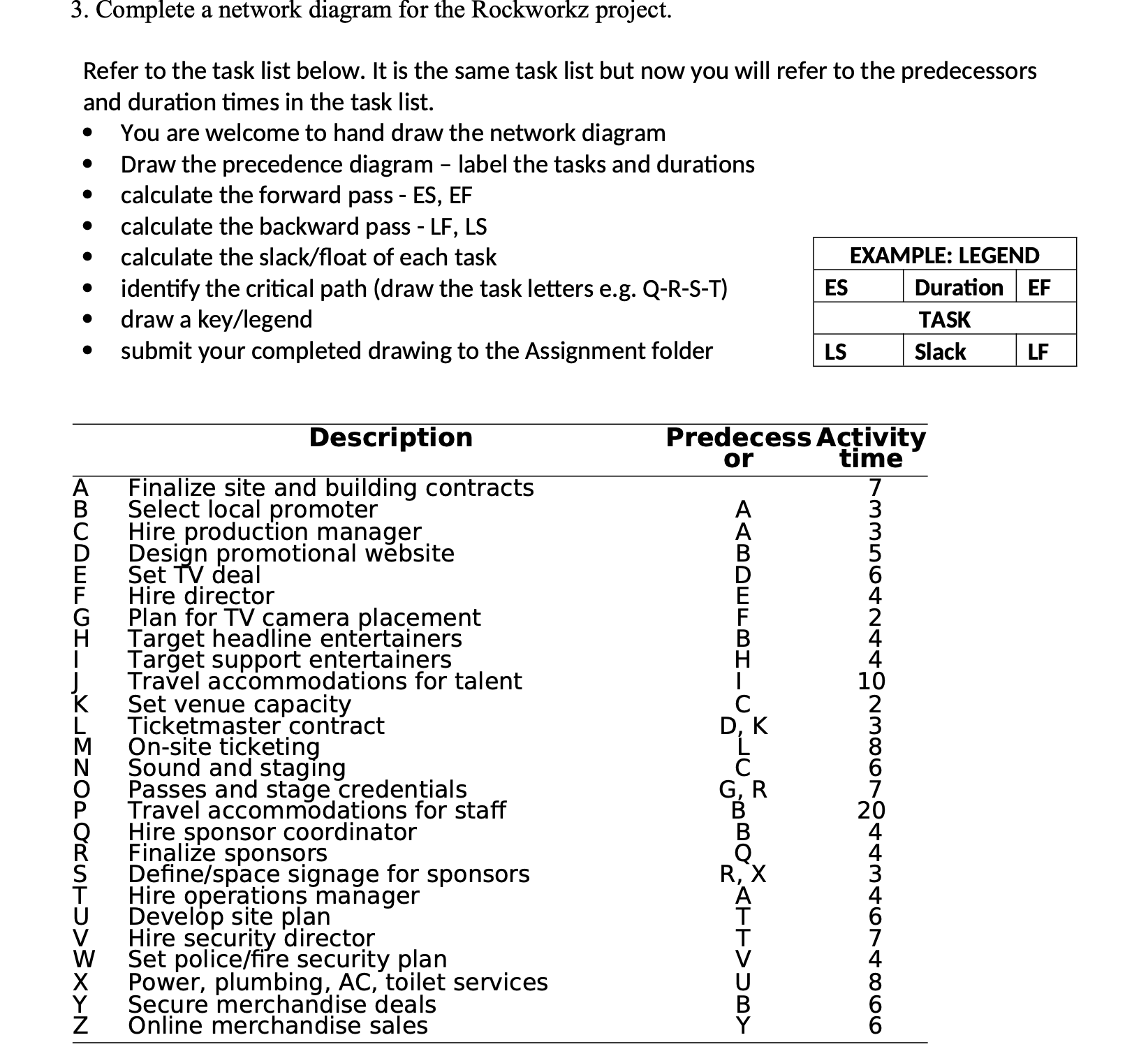

3. Complete a network diagram for the Rockworkz project. Refer to the task list below. It is the same task list but now you will refer to the predecessors and duration times in the task list. - You are welcome to hand draw the network diagram - Draw the precedence diagram - label the tasks and durations - calculate the forward pass - ES, EF - calculate the backward pass - LF, LS - calculate the slack/float of each task - identify the critical path (draw the task letters e.g. Q-R-S-T) - draw a key/legend - submit your completed drawing to the Assignment folder
