Question: Problem #2 Complete this table using the information below for the project AT THE END OF WEEK Activity Percent BCWS Complete BCWP BCWP (using 50/50

Problem #2 Complete this table using theProblem #2 Complete this table using theProblem #2 Complete this table using theProblem #2 Complete this table using the

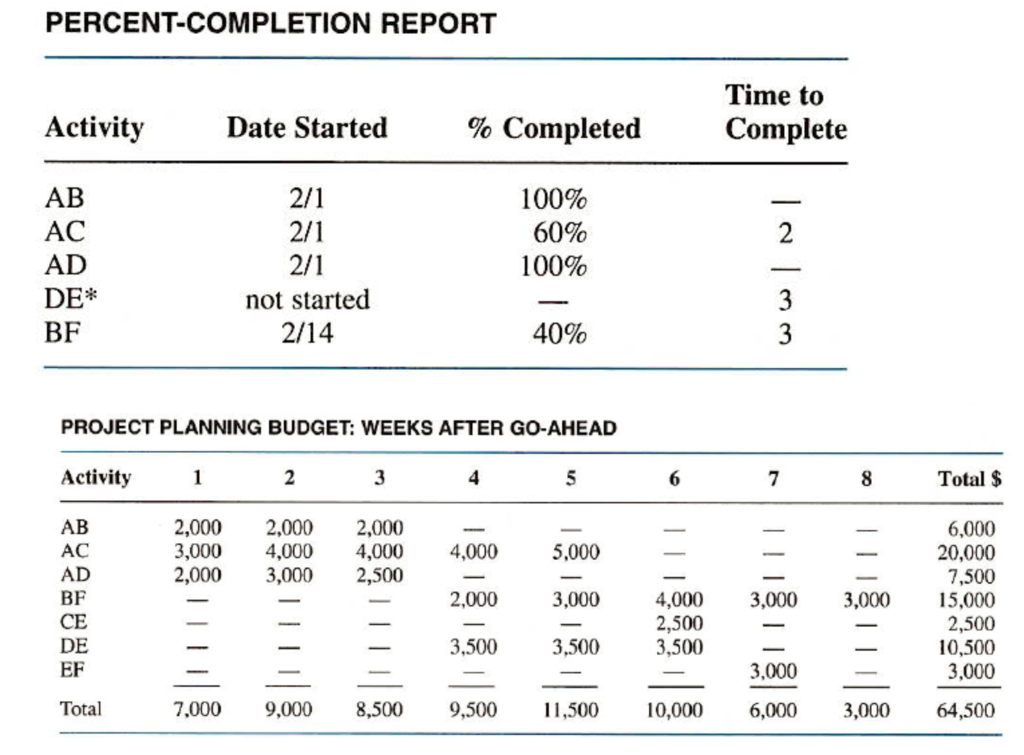

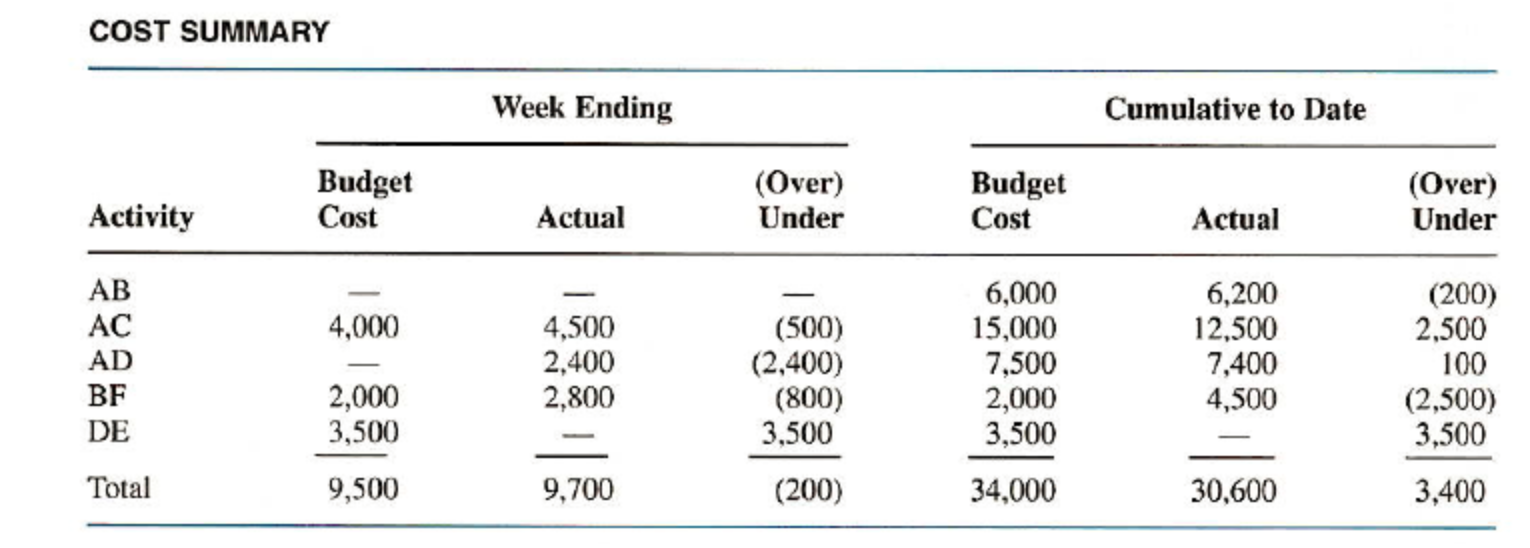

Problem #2 Complete this table using the information below for the project AT THE END OF WEEK Activity Percent BCWS Complete BCWP BCWP (using 50/50 Rule) ACWP CV SV CV SV (using (using 50/50 50/50 Rule) Rule) Network Logic: 5 5 3 (Time = weeks) PERCENT COMPLETION REPORT Activity Date Started % Completed Time to Complete AB AC AD DE* 2/1 2/1 2/1 not started 2/14 100% 60% 100% | | BF 40% PERCENT-COMPLETION REPORT Activity Date Started % Completed Time to Complete AB AC AD 2/1 2/1 2/1 not started 2/14 100% 60% 100% | | DE* BF 40% PROJECT PLANNING BUDGET: WEEKS AFTER GO-AHEAD Activity 1 2 3 4 5 6 7 8 Total $ 2,000 3,000 2,000 2.000 4,000 3,000 2,000 4,000 2,500 4,000 5.000 11 1 AB AC AD BF CE DE EF 2,000 3,000 3,000 3,000 4,000 2,500 3,500 6,000 20,000 7,500 15,000 2,500 10,500 3,000 | | 3,500 3,500 3,000 Total 7.000 9,000 8,500 9,500 11,500 10,000 6,000 3,000 64,500 COST SUMMARY Week Ending Cumulative to Date Activity Budget Cost (Over) Under Budget Cost (Over) Under Actual Actual AB AC AD BF 4,000 4,500 2,400 2,800 (500) (2,400) (800) 3,500 6,000 15,000 7,500 2,000 3,500 6,200 12,500 7,400 4,500 (200) 2,500 100 (2,500) 3,500 DE 2,000 3,500 Total 9,500 9,700 (200) 34,000 30,600 3,400

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock

Summary The table was completed using earned value management formulas with bot... View full answer

blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
