Question: Complete this table using the information below for the project AT THE END OF WEEK # 4 . Activity Percent Complete BCWS BCWP BCWP (

Complete this table using the information below for the project AT THE END OF WEEK #4.
Activity
Percent Complete
BCWS
BCWP
BCWP (using 50/50 Rule)
ACWP
CV
SV
CV (using 50/50 Rule)
SV (using 50/50 Rule)
PERCENT-COMPLETION REPORT
\table[[Activity,Date Started,% Completed,\table[[Time to],[Complete]]],[AB,21,100%,-],[AC,21,60%,2],[AD,21,100%,-],[DE*,not started,-,3],[BF,214,40%,3]]
PERCENT-COMPLETION REPORT
\table[[Activity,Date Started,% Completed,\table[[Time to],[Complete]]],[AB,21,100%,-],[AC,21,60%,2],[AD,21,100%,-],[DE,not started,-,3],[BF,214,40%,3]]

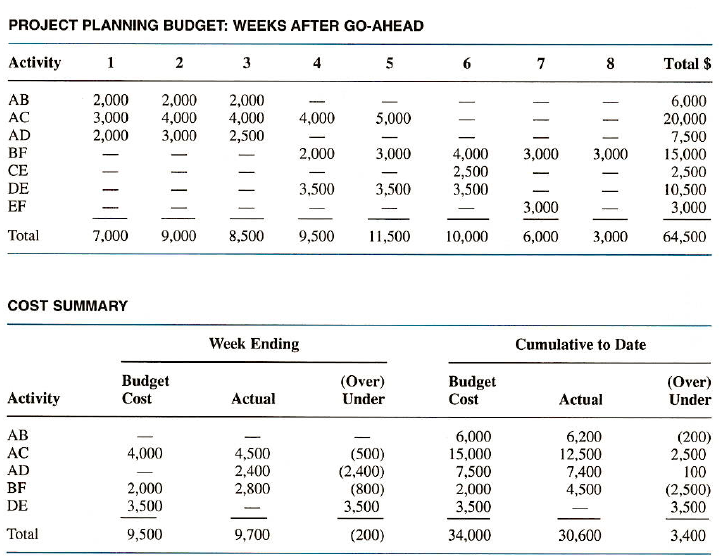

PROJECT PLANNING BUDGET: WEEKS AFTER GO-AHEAD
\table[[Activity,1,2,3,4,5,6,7,8,Total $],[AB,2,000,2,000,2,000,-,-,-,-,-,6,000],[AC,3,000,4,000,4,000,4,000,5,000,-,-,-,20,000],[AD,2,000,3,000,2,500,-,-,-,-,-,7,500],[BF,-,-,-,2,000,3,000,4,000,3,000,3,000,15,000],[CE,-,-,-,-,-,2,500,-,-,2,500],[DE,-,-,-,3,500,3,500,3,500,-,-,10,500],[EF,-,-,-,-,-,-,3,000?,-,3,000],[Total,7,000,9,000,8,500,9,500,11,500,10,000,6,000,3,000,64,500]]
COST SUMMARY
\table[[Activity,Week Ending,Cumulative to Date],[\table[[Budget],[Cost]],Actual,\table[[(Over)],[Under]],\table[[Budget],[Cost]],Actual,\table[[(Over)],[Under]]],[AB,-,-,-,6,000,6,200,(200)],[AC,4,000,4,500,(500),15,000,12,500,2,500],[AD,-,2,400,(2,400),7,500,7,400,100],[BF,2,000,2,800,(800),2,000,4,500,(2,500)
 Complete this table using the information below for the project AT

Step by Step Solution

There are 3 Steps involved in it

1 Expert Approved Answer
Step: 1 Unlock blur-text-image
Question Has Been Solved by an Expert!

Get step-by-step solutions from verified subject matter experts

Step: 2 Unlock
Step: 3 Unlock

Students Have Also Explored These Related General Management Questions!
