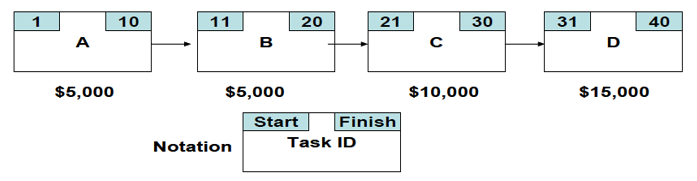

Question: Task A, B, C, and D are the critical path of the project. Each task is 10 days in duration and their costs are as

- Task A, B, C, and D are the critical path of the project.
- Each task is 10 days in duration and their costs are as shown in the diagram.
- At the end of day 23, Tasks A and B are complete. Task C is 50% complete and, up to this point, $14,000 has been spent overall.
Planned Value (PV)
= The planned value of the work planned to be done
= Estimated cost of the planned work at the end of day 23
=Task A + Task B + 3 * $1,000 (Task C)
= $5,000 + $5,000 + $3,000
= $13,000
As the Project Manager (PM), at the end of day 23, calculate:
- What is AC (Actual Cost)?
- What is BAC (Budget at Completion)?
- What is EV (Earned Value)?
- What is CPI (Cost Performance Index)?
- What is SPI (Schedule Performance Index)?
- What is EAC (Estimate at Completion)?
- What are the variances (SV, CV, VAC)?
