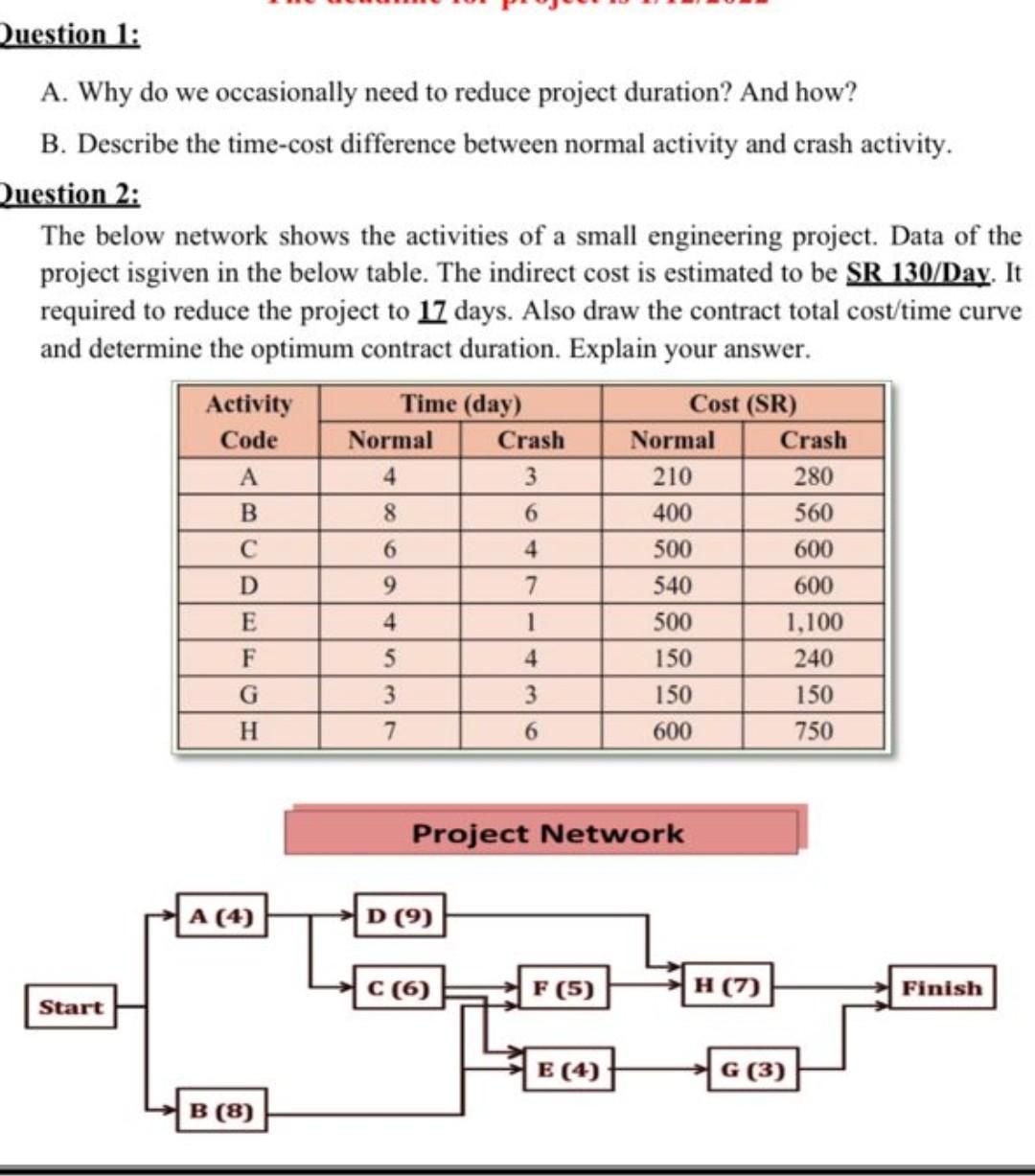

Question: uestion 1: A. Why do we occasionally need to reduce project duration? And how? B. Describe the time-cost difference between normal activity and crash activity.

uestion 1: A. Why do we occasionally need to reduce project duration? And how? B. Describe the time-cost difference between normal activity and crash activity. uestion 2: The below network shows the activities of a small engineering project. Data of the project isgiven in the below table. The indirect cost is estimated to be SR 130/Day . It required to reduce the project to 17 days. Also draw the contract total cost/time curve and determine the optimum contract duration. Explain your
