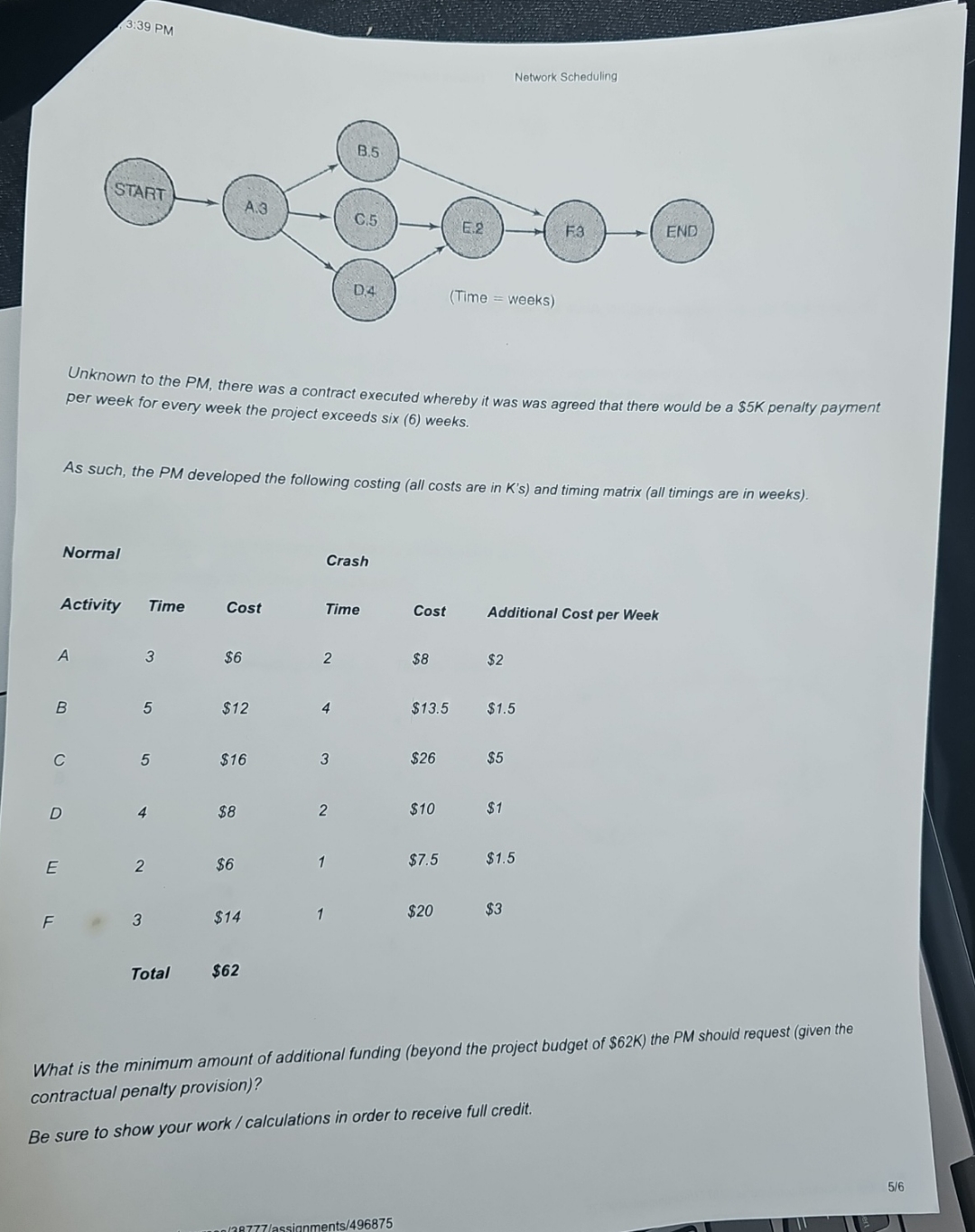

Question: Unknown to the PM , there was a contract executed whereby it was was agreed that there would be a $ 5 K penalty payment
Unknown to the PM there was a contract executed whereby it was was agreed that there would be a $ penalty payment
per week for every week the project exceeds six weeks.
As such, the PM developed the following costing all costs are in Ks and timing matrix all timings are in weeks
