Question: Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project
Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project by 3 weeks in the most economical way.
| Activity | Normal Time (weeks) | Normal Cost ($) | Crash Time (weeks) | Crash Cost ($) | Maximum weeks Reduced | Crash Cost per Week ($) | ||||||
|---|---|---|---|---|---|---|---|---|---|---|---|---|
| A | 3 | 500 | 2 | 900 | 1 | 400 | ||||||
| B | 4 | 600 | 3 | 700 | 1 | 100 | ||||||
| C | 6 | 800 | 3 | 1,340 | 3 | 180 | ||||||
| D | 6 | 1,500 | 4 | 2,150 | 2 | 325 | ||||||
| E | 6 | 1,750 | 4 | 2,250 | 2 | 250 | ||||||
| F | 5 | 1,200 | 5 | 1,200 | 0 | 0 | ||||||
| G | 7 | 1,500 | 5 | 1,830 | 2 | 165 | ||||||
| H | 3 | 500 | 3 | 500 | 0 | 0 |

Reduce G ---------------------C by ------------------- weeks , at cost of $ .-------------------

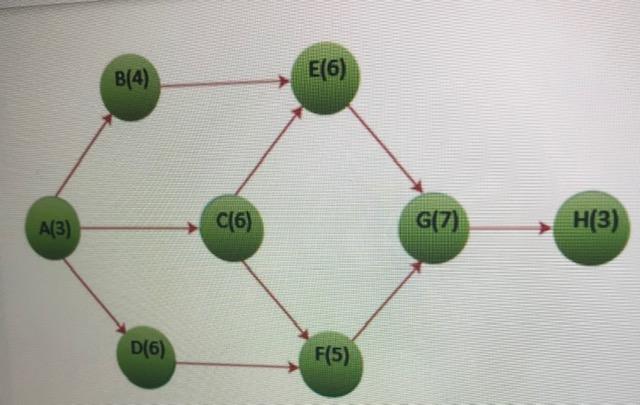

B(4) E(6) A(3) C[6) G(7) H(3) D(6) FStep by Step Solution
