Question: You have just received your progress update for your 13 week project (it is now the end of week 9). Based on the plan, shown

You have just received your progress update for your 13 week project (it is now the end of week 9). Based on the plan, shown in the attached Gantt Chart complete with planned costs,

Create a spreadsheet that calculates your cost and schedule variances and indexes.

You have just received your progress update for your 13 week project(it is now the end of week 9). Based on the plan,shown in the attached Gantt Chart complete with planned costs,Create a spreadsheet

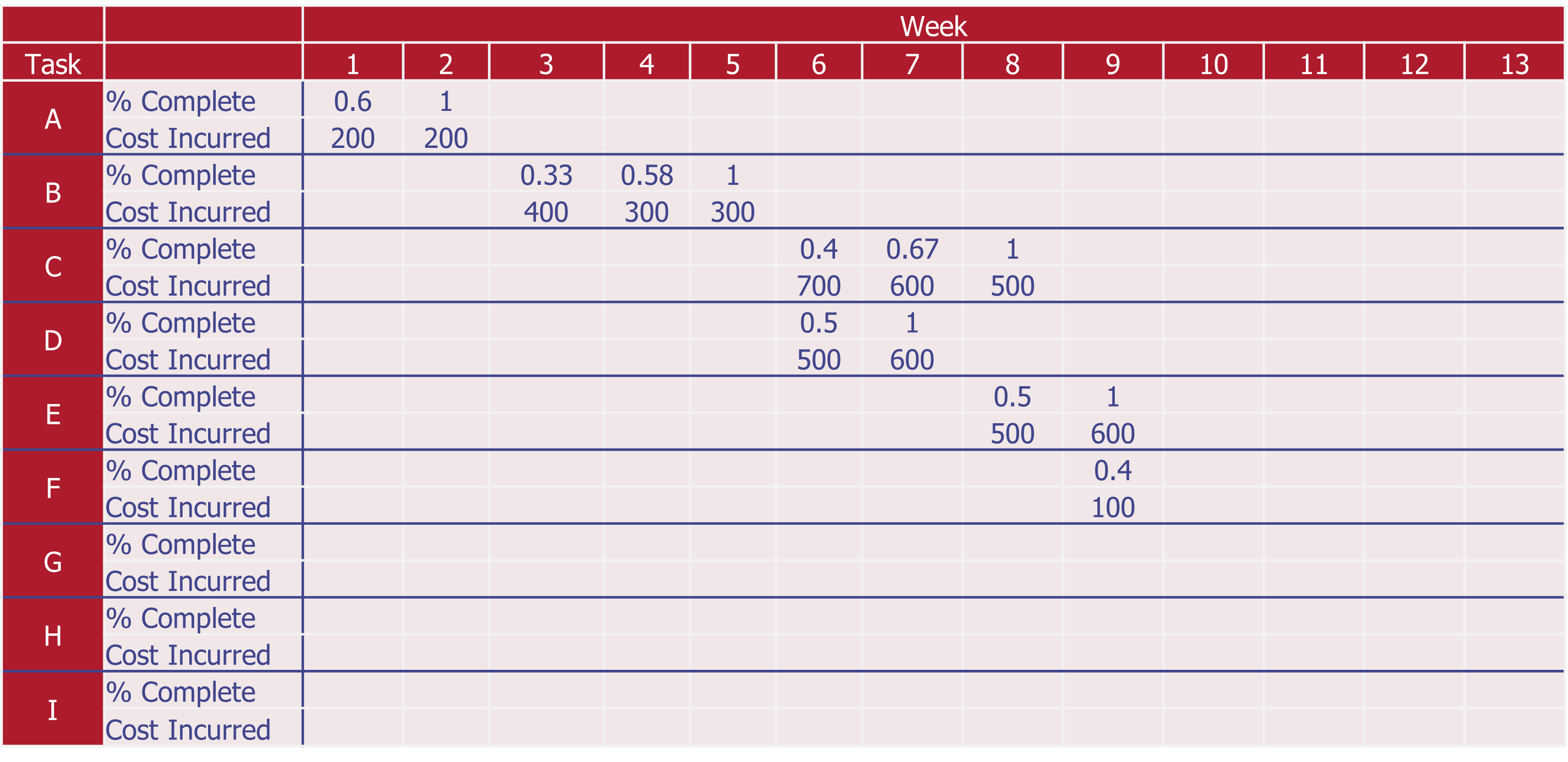

Week Task 1 2 3 4 5 6 7 8 9 10 11 12 13 A % Complete 0.6 1 Cost Incurred 200 200 B % Complete 0.33 0.58 1 Cost Incurred 400 300 300 C % Complete 0.4 0.67 1 Cost Incurred 700 600 500 D % Complete 0.5 1 Cost Incurred 500 600 E % Complete 0.5 1 Cost Incurred 500 600 F % Complete 0.4 Cost Incurred 100 G % Complete Cost Incurred H % Complete Cost Incurred I % Complete Cost Incurred\fTask % Planned Incurred Complete Cost Cost (to date) A 100 500 400 100 1200 1000 C 100 1500 1800 100 800 1100 25 2000 TI M O 800 O 700 O G 100 900 1200 H 20 500 100 H 0 600 O
