Question: Given below is the baseline planned value (PV) budget information for a project. Provide a status report as of the end of Period 4. Formula:
Given below is the baseline planned value (PV) budget information for a project. Provide a status report as of the end of Period 4.
Formula:
| EV = % complete*PV CV = EV - AC CPI = EV / AC SV = EV - PV SPI = EV / PV | PCIB = EV/BAC ETC = [(BAC - EV) / CPI] EACf = AC + [(BAC - EV) / CPI] VAC = BAC-EACf |

End of Period 4
| Task | Actual % | EV | AC | PV | CV | SV |
| Complete | $ | $ | $ | $ | $ | |
| A | Finished | 300 | 400 | |||
| B | 50% | 1000 | 800 | |||
| C | 30% | 500 | 600 | |||
| D | 0% | 0 | ||||
| E | 0% | |||||
| Cumulative Totals | 2100 | |||||
What percentage of the entire project has been completed as of the end of period 4? (hint: use PCIB)
16.2%
61.2%
85.7%
28.3%
14.2%

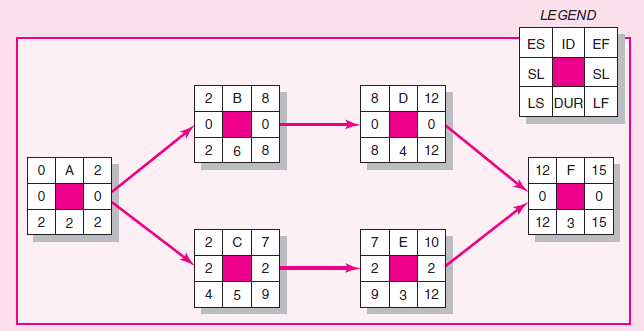

LEGEND ES ID EF SL SL 2 B8 8 D 12 0 0 LS DUR LF O 0 0 2 68 84 12 0 A 2 12 F 15 0 0 0 0 22 2 12 3 15 2 C 7 7 E 10 2 2 2 2 4 59 9 3 12 Project baseline (PV) (in $) Task DUR ES LF SL 10 11 12 13 14 15 Budget (PV) o 1 2 3 4 5 6 7 8 9 400 200 200 2400 200 600 200 600 200 600 2 0 2 0 B 6 2 0 5 2 9 2 1500 200 400 500 100 300 D 4 8 12 0 E 3 7 12 1600 400 400 400 400 2 900 300 400 200 0 200 100 300 Period PV total 200 200 400 1000 700 700 500 900 800 600 400 400 200 100 300 F 3 12 15 600 Cumulative PV total 200 400 800 1800 2500 3200 3700 4600 5400 6000 6400 6800 7000 7100 7400Step by Step Solution
