Part 2
Remember the old saying, A project plan is not a schedule until resources are committed. This exercise illustrates this sometimes subtle, but important point.
Using your files from Part 1, input resources and their costs if you have not already done so. All information is found in Tables A2.1 and A2.2.
Prepare a memo that addresses the following questions:
1. Which if any of the resources is overallocated?
2. Assume that the project is time constrained and try to resolve any overallocation problems by leveling within slack. What happens?
3. What is the impact of leveling within slack on the sensitivity of the network?
Include a schedule table which shows the start, finish, late start, late finish, free slack and total slack, AND a Gantt chart with the schedule table after leveling within slack.
4. Assume the project is resource-constrained and resolve any overallocation problems by leveling outside of slack. What happens?
Include a schedule table which shows the start, finish, late start, late finish, free slack and total slack, AND a Gantt chart with the schedule table after leveling outside of slack.
Note: No splitting of activities is allowed.
Note: No partial assignments (i.e., 50 percent). All resources must be assigned 100 percent.
Your submission is subject to the SafeAssign scanning. Do not include the questions in the report. Use your words to explain the project outputs.
The last six pictures is the information from part one used to complete part two, please make sure you include two scheduled tables and two gantt charts (1 each for questions 3+4) PLEASE MAKE SURE IT IS big enough to read and screenshot. thank you. PLEASE DONT COPY AND PASTE THE LONG ANSWER THAT STARTS WITH " 1A OVERALLOCTED FIELDS as this is incorrect"

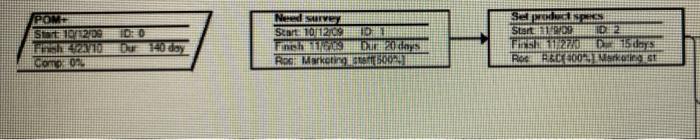

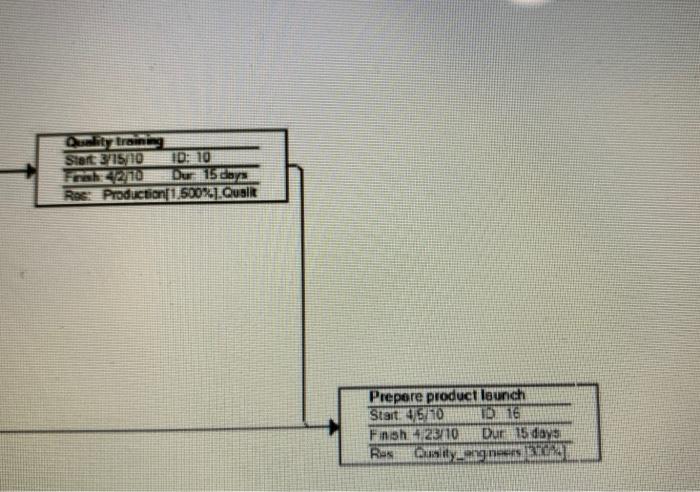

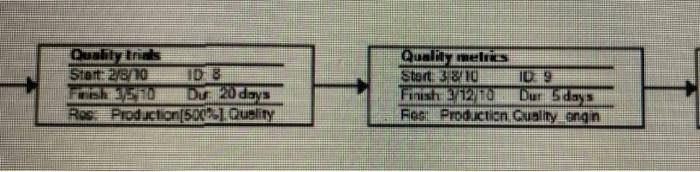

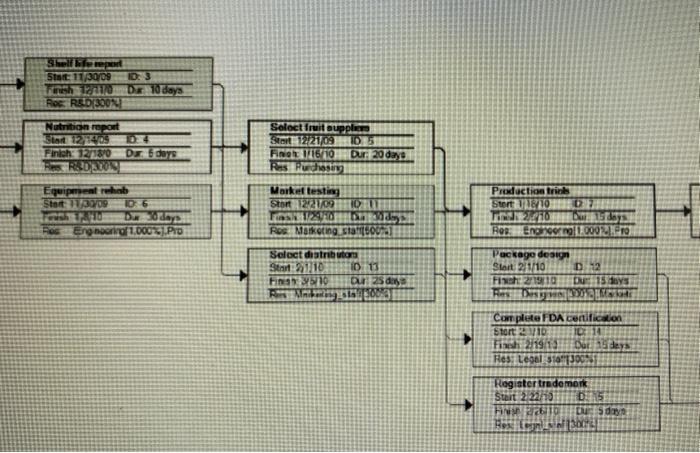

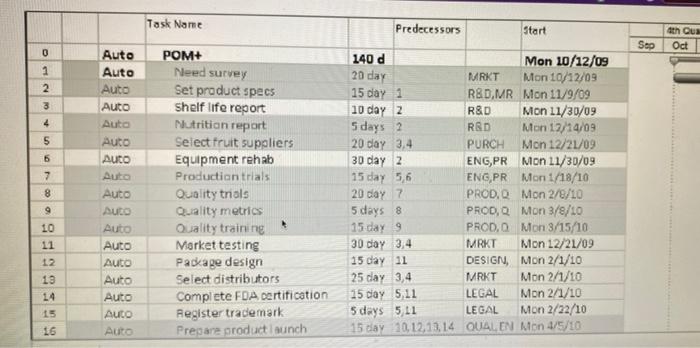

Task Name Predecessors Start ath Qus Oct Sep 0 1 2 3 4 5 6 7 8 Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto Auto AUCO Auto POM+ Need survey Set product specs shelf life report Nutrition report Select fruit suppliers Equipment rehab Production trials Quality tnals Quality metrics Quality training Market testing Package design Select distributors Complete FDA certification Register trademark Pregare product launch 140 d Mon 20/12/09 20 day MRKT Mon 10/12/09 15 day 1 R&DMR Mon 11/9/09 10 day 2 R&D Mon 11/30/09 5 days 2 RED Mon 17/14/09 20 day 3,4 PURCH Mon 12/21/09 30 day 2 ENG,PR MON 11/30/09 15 day 5,6 ENG,PR Mon 1/18/10 20 day 7 PROD.Q Mon 2/8/10 5 days 8 PROD,Q Mon 3/8/10 15-day 9 PRODO Mon 3/15/10 30 day 3,4 MRKT Mon 12/21/09 15 day 11 DESIGN, Mon 2/1/10 25 day 3,4 MRKT Mon 2/1/10 15 day 5.11 LEGAL Mon 2/1/10 5 days 5,01 LEGAL Mon 2/22/10 15 day 10,12,13,14 QUALEN Mon 4/5/10 9 10 11 12 13 14 15 16 Ath Quarter Oct 1st Quarter Fob Sep Nov Dec 2nd Quarter Apr May Jun Jan Mar 3rd Quarter Aug 4th Quarter Oct Noy C Jul Sep 19 RAD[2004] Engneering[1,000% 1.Production[2,000%] Marketing scarff[500%) Designet -300%, Marketing staff Marketing staff[300%) tegut 4+ [300%) Hentaff[300%) POM Start 10/12/900 ESTAT40 y com 0 Need surve Start101209 101 DHE Rod Marketing 0017 Seeds Start DD ID: 2 FINS 27/0 Days RECOM Shelfer Start: 11/30/09 ID 3 ish to De 10 days Roc RED 300 Nutrition report 121405 Finish 12180 Dr days R2DEOS Select fruit supplier Stat122103 075 Finch 11/16/10 Dur 20 day Pudung Equip rehab Start13.09 sh 110 DEL o En noord 1 J.Pro Marke testing Stort 122109 1001 F10 ROB Marketing Star Production trinks Stort U10 02 2410 Dados Ros Enoron 0000 Select distributor Start 21710 1013 Hins 9 10 Qui 25 165003 Package design Stort 21/10 D2 Fich: 1910 DE 15 toys DJ VIDIMORE Complete FDA certification Stort 3D 1 Fine 219/12 Derdeyse Hes: Legal 510TJ0021 Register trademark Stait 2 o D15 HNNO dy Ben 10 Quality trials Stert: 2/8/10 ID 8 FR10 D20 days Ros Production[50402_1.Quelity Qulit meiros Stert 380 TU9 Fish 270 Dur5 days Fios Production Guality engin Damit train Start 3:15 10 ID: 10 shum 15 Res Production 15002].Quaik Prepere product launch Start 5/10 T16 Finish 123/10 Duri 15 days Re
