Question: project management Question 9 2.5 pts Here is some data for Project ABC Budget $ 5,418 thousand Start Workday 8 Finish Workday 108 Reporting Day
project management

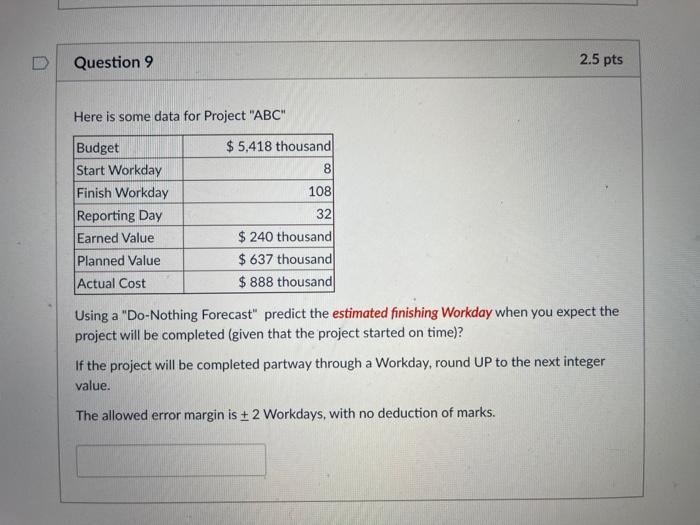

Question 9 2.5 pts Here is some data for Project "ABC" Budget $ 5,418 thousand Start Workday 8 Finish Workday 108 Reporting Day 32 Earned Value $ 240 thousand Planned Value $ 637 thousand Actual Cost $ 888 thousand Using a "Do-Nothing Forecast" predict the estimated finishing Workday when you expect the project will be completed (given that the project started on time)? If the project will be completed partway through a Workday, round UP to the next integer value. The allowed error margin is + 2 Workdays, with no deduction of marks
