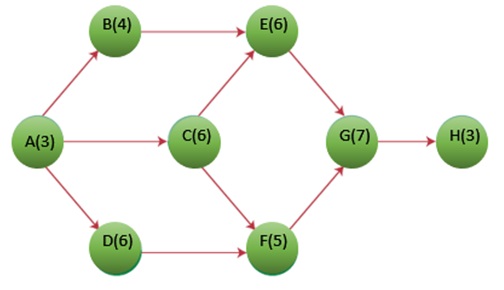

Question: Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project

Using the information provided in the table, the network diagram and the project completion time = 25 weeks, reduce the completion time of the project by 3 weeks in the most economical way.

ActivityNormal Time (weeks)Normal Cost ($)Crash Time (weeks)Crash Cost ($)Maximum weeks ReducedCrash Cost per Week ($)
A350029001400
B460037001100
C680031,3373179.00
D61,50042,1502325
E61,75042,2502250
F51,20051,20000
G71,50051,8282164
H3500350000

Using the information provided in the table, the
B(4) E(6) G(7) H(3) A(3) C(6) D(6) F
