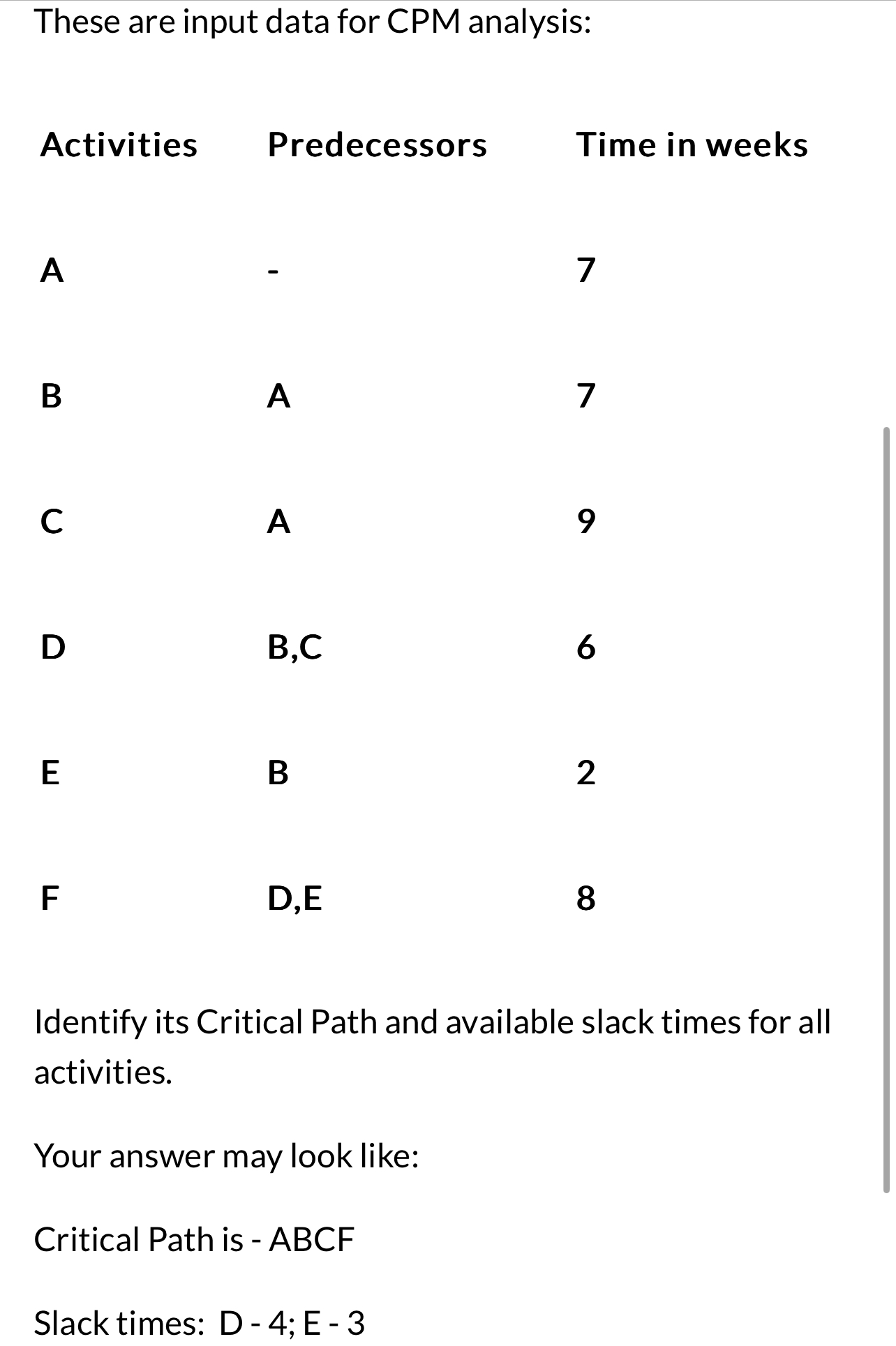

Question: These are input data for CPM analysis: Activities Predecessors Time in weeks A 7 B A 7 C A 9 D B , C 6

These are input data for CPM analysis:
Activities Predecessors Time in weeks
A
7
B
A
7
C
A
9
D
B,C
6
E
B
2
F
D,E
8
Identify its Critical Path and available slack times for all
activities.
Your answer may look like:
Critical Path is - ABCF
Slack times: D -4; E -3
